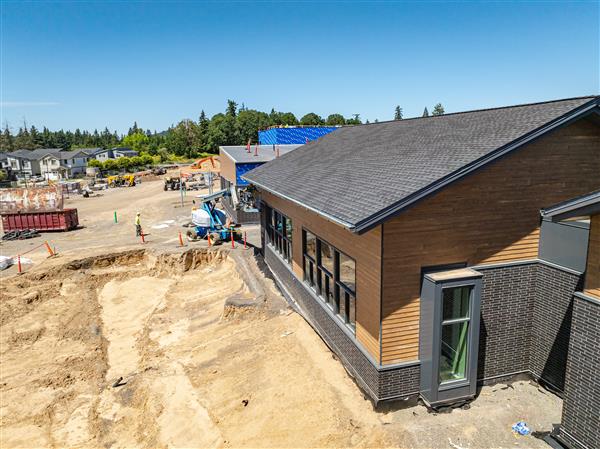

• 2024 Q1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/23/2024

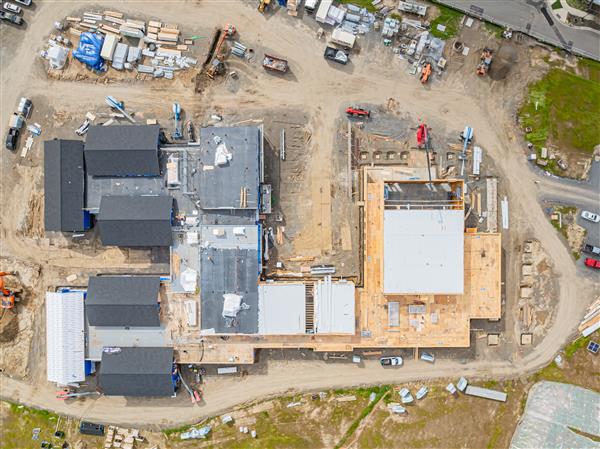

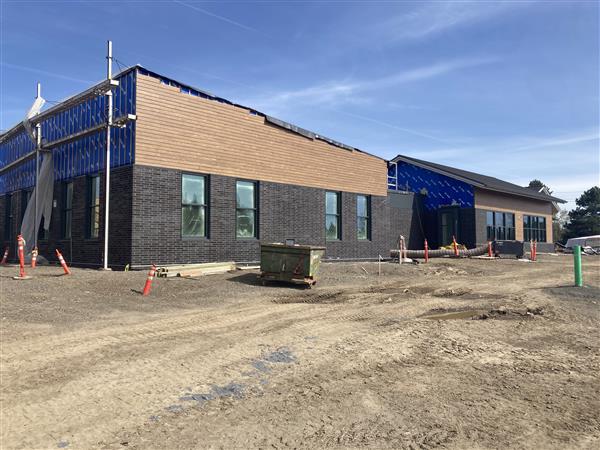

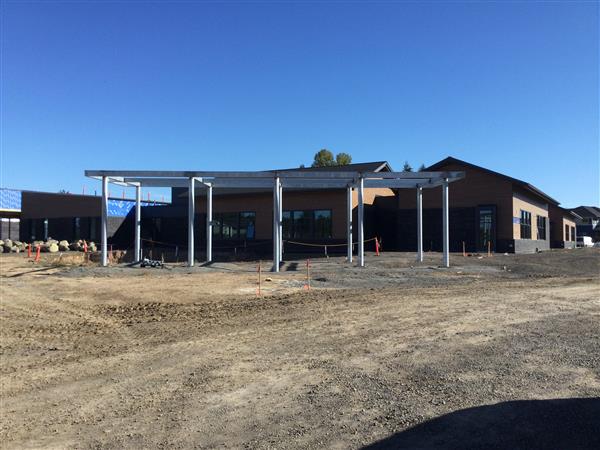

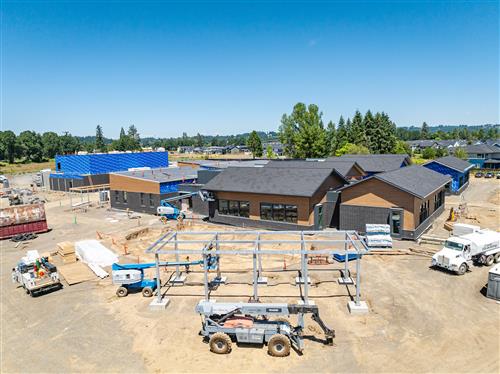

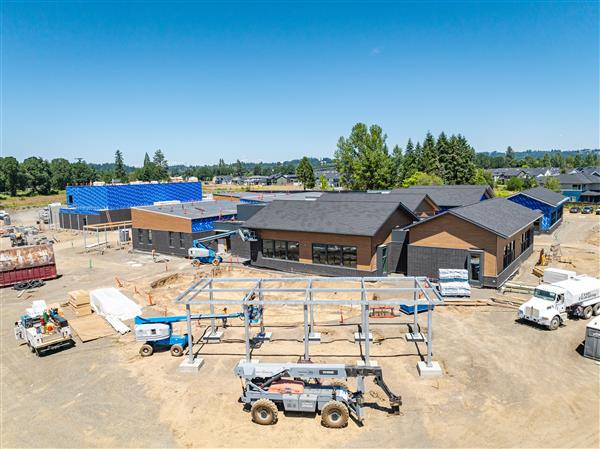

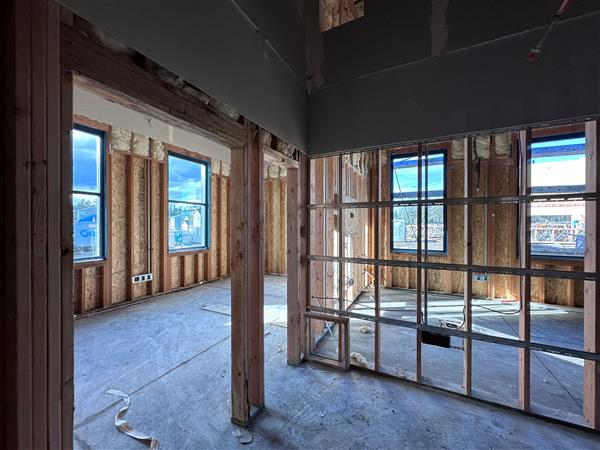

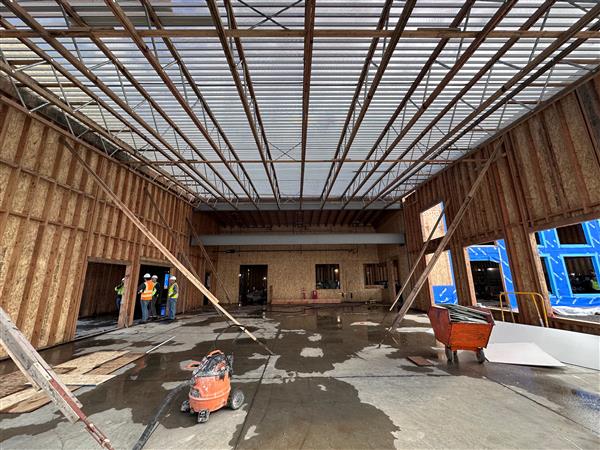

    Drone image of school construction

    Recent Activities:

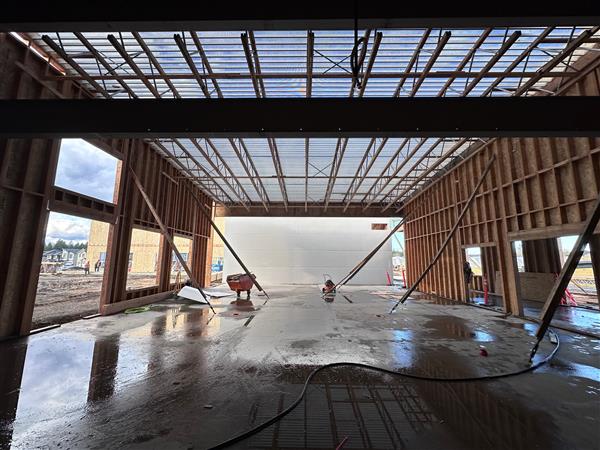

    ■    The exterior framing of the building is complete

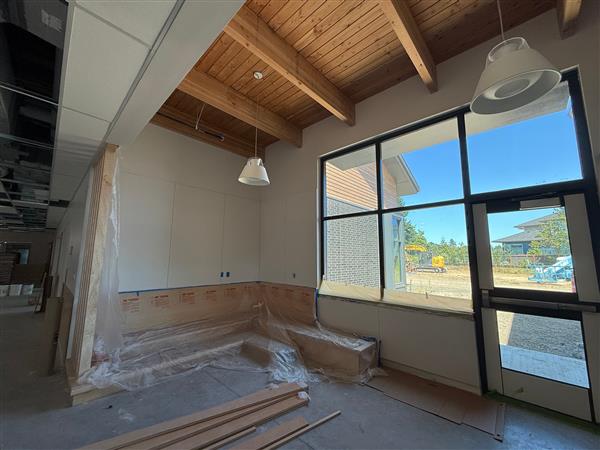

    ■    Installation of exterior finishes such as, brick, fiber cement siding, waterproofing products and windows continues to progress around the perimeter of the building
    ■    Mechanical, electrical and plumbing work continues to follow framing throughout the building

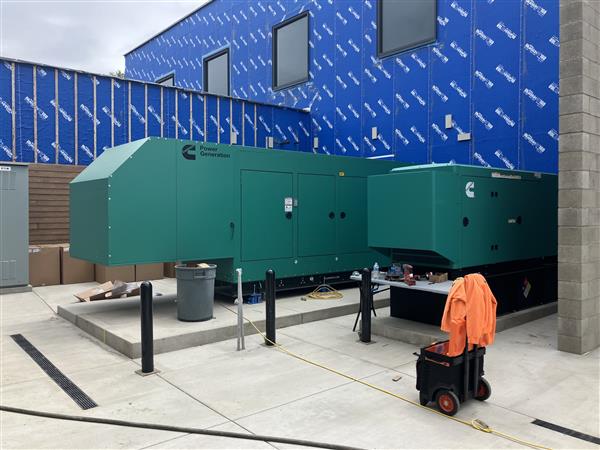

    ■    Underground utilities continue to be installed throughout the site and will continue as construction progresses. Utility connections along Sherman Drive have been completed

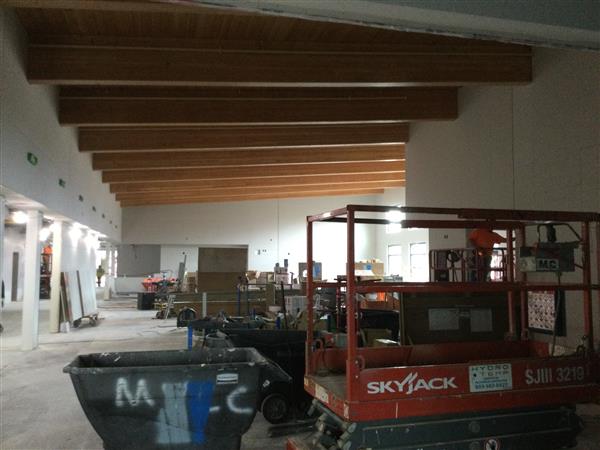

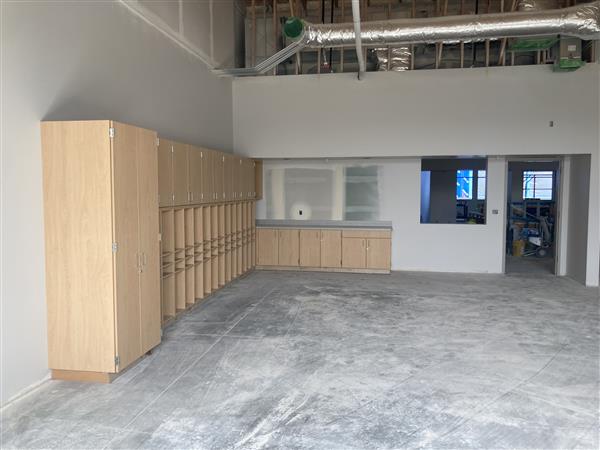

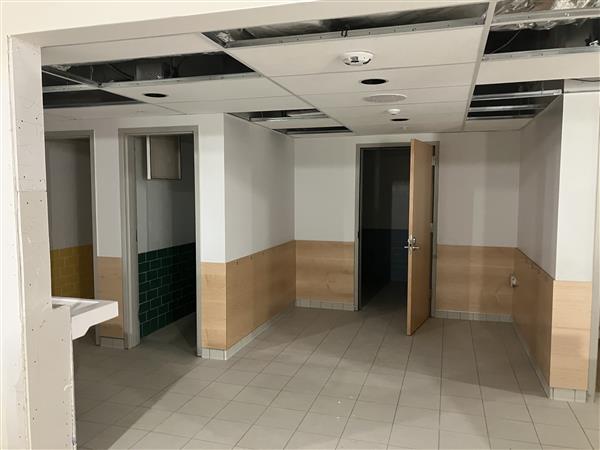

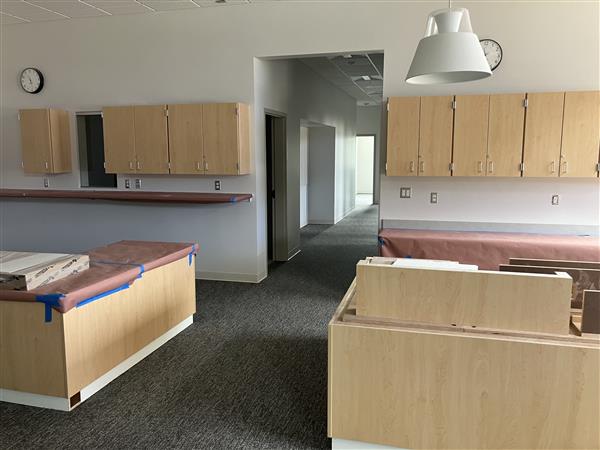

    ■    Completion of many of the classroom asphalt roofs have allowed for installation of drywall, door drains and casework
    ■    The sanitary sewer and storm lines have been installed along Brisdband Street. Installation of the public water line has begun

    Upcoming Activities:
    ■    Construction of stormwater planters along Brisband Street to begin in the near future
    ■    Coordination continues to occur between the School District and the Boeckman Road Corridor Improvements Project
    ■    Construction of the exterior canopies around the building to begin soon
    ■    Completion of the public water line

    Comments (-1)
  • 2023 Q4 Project Updates

    Posted by West Linn - Wilsonville School District on 1/25/2024

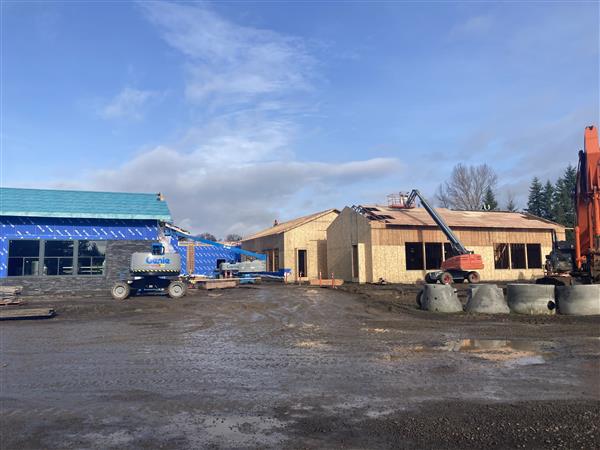

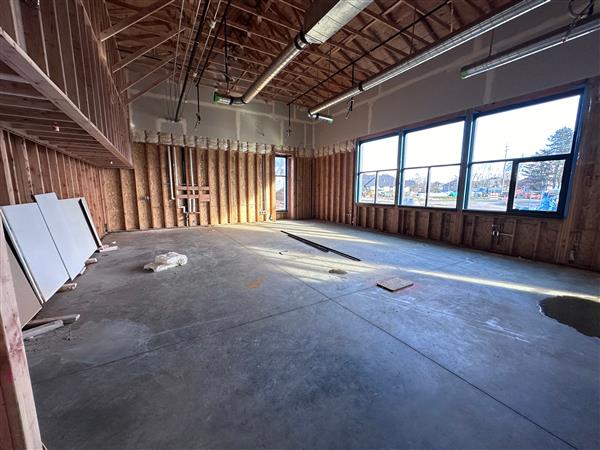

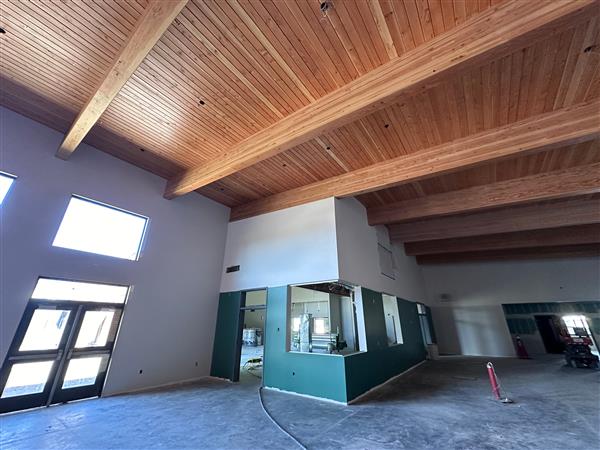

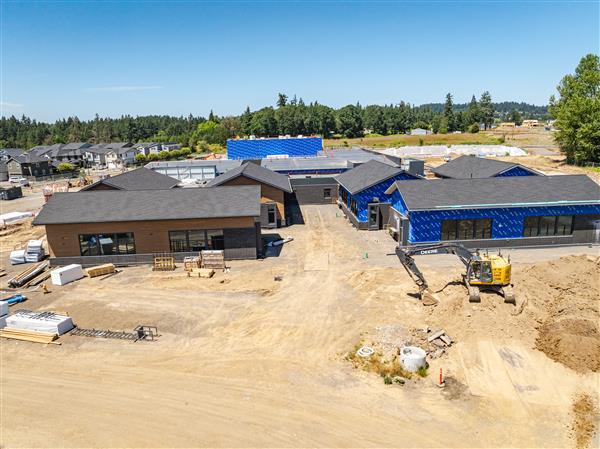

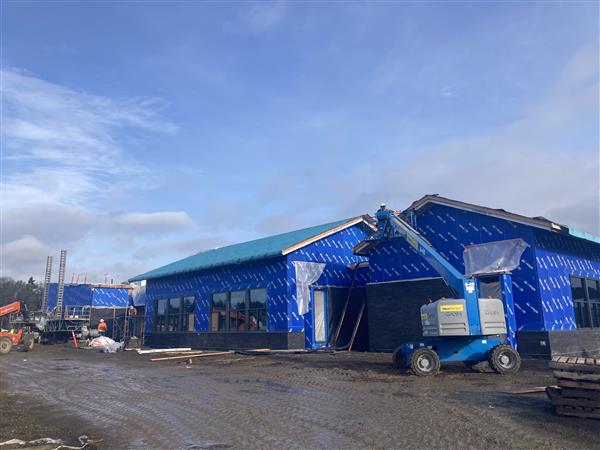

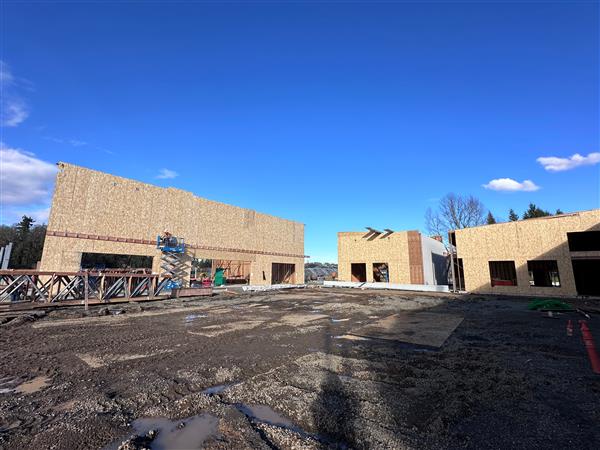

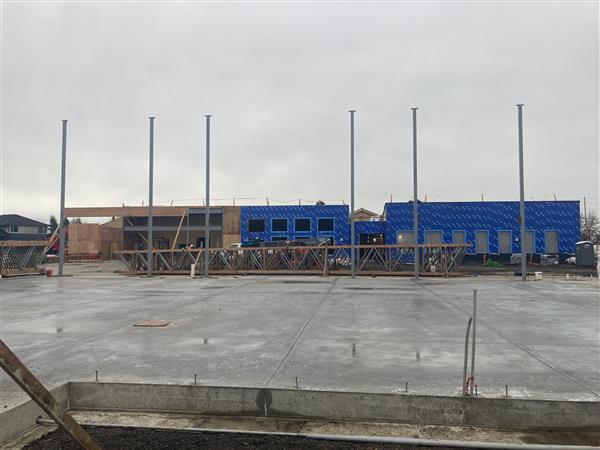

    exterior construction of school building

    Recent Activities:
    ■    Framing continues with a substantial portion of the building largely complete. The entry vestibule, library, offices and many classrooms are fully framed
    ■    Underground utility installation is underway with utility connections along Sherman Drive complete
    ■    Installation of exterior finishes such as brick, waterproofing and windows has begun
    ■    The entirety of the building’s concrete floor slab is complete

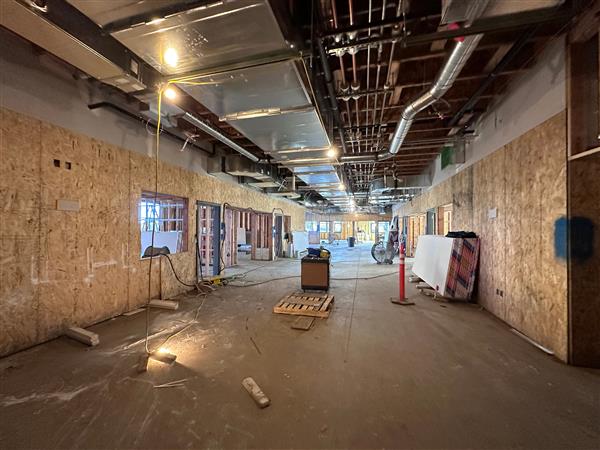

    ■    Plumbing, HVAC and electrical rough-ins have started in the classrooms and offices
    ■    Installation of roofing is underway

    Upcoming Activities:
    ■    Storm and sewer piping installation along the Brisband Street connection is expected to begin late January
    ■    Remaining framing for gym, kitchen, music room and multi-purpose room
    ■    Installation of plumbing, HVAC and electrial to follow remaining framing work
    ■    Coordination between the City of Wilsonville and the District continues for the construction of the school and the City’s work on the Boeckman Road Corridor Improvements project

    Comments (-1)
  • 2023 Q3 Project Updates

    Posted by West Linn - Wilsonville School District on 10/31/2023

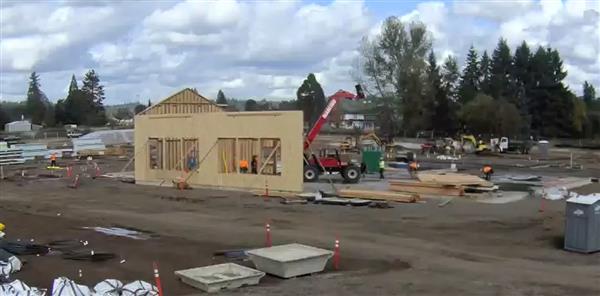

    construction

    Recent Activities:

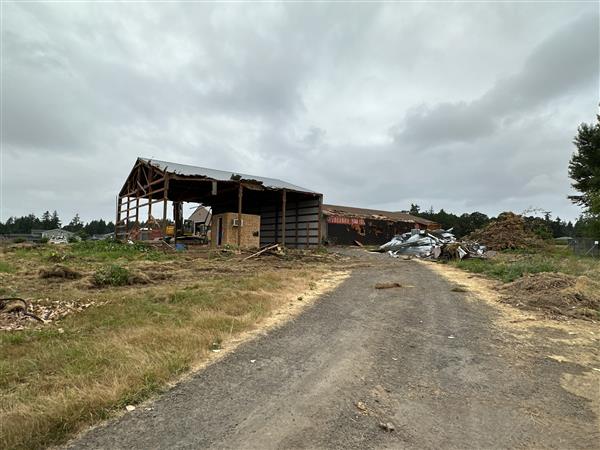

    ■    The existing house and barns on the property were demolished and removed from the site
    ■    Significant site grading occurred and the existing wells on site were decommissioned
    ■    Erosion control and tree protection measures, such as hydroseeind, silt fences and sediment ponds were imple-mented throughout the site
    ■    Uderground utilities have been installed and the buildings footings have been poured

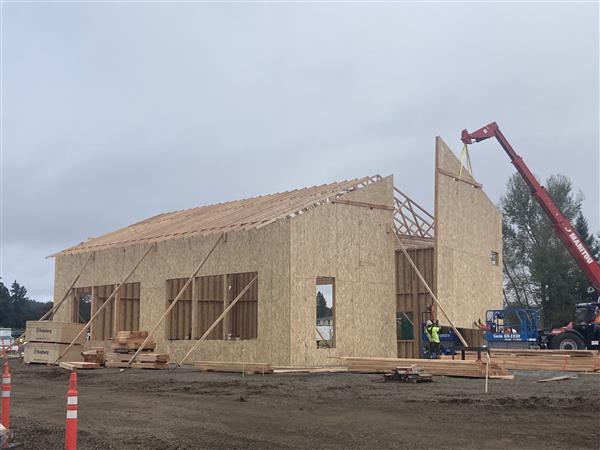

    ■    The first classroom sections framing has begun

    Upcoming Activities:
    ■    Work has begun on the street improvements for both Sherman Drive and Brisband Street. Connections for utili-ties to be completed in the coming weeks
    ■    The installation of concrete floor slab, as well as wood-framed structure continues
    ■    Coordination between the City of Wilsonville and the District continues for the construction of the school and the City’s work on the Boeckman Road Corridor Improvements project

    Comments (-1)
  • 2023 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 7/20/2023

    Dirt construction site

    Recent Activies:
         Board approved contract with alternates
         Contract executed
         Abatement of existing buildings complete
         Contractor mobilized to the site

    Upcoming Activities:
         Continued coordination between the City of Wilsonville and the District for the school work and City's work on the Boeckman Road Coordinator Improvements project
         Completion of erosion control and tree protection measures
         Start of construction

    Comments (-1)
  • Community Celebrates Groundbreaking for New Primary School

    Posted by West Linn - Wilsonville School District on 6/14/2023

    School Board Directors, City Leaders, and School District Staff officially broke ground on the New Primary School at Frog Pond on June 12.

    The new primary school is part of the 2019 Capital Bond to address enrollment growth as the Frog Pond neighborhood builds out. The 350-student starter school will open in 2025-26.

    Interested community members can take a virtual tour of the new school by clicking here

    Comments (-1)
  • 2023 Q1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/20/2023

    Front of building rendering

    Recent Activities:
      The project was granted land use approval at the City of Wilsonville Development Review Board April 10th
      An abatement package was bid and a contract has been executed for abatement of the existing house on the property.
      Project bids were received on April 11th

    Upcoming Activities:
      The project will go to the school board on April 17th for contractor approval.
      Continued coordination between the City of Wilsonvillea and the district for the school work and the city's work on the Boeckman Road Corridor Improvements project.
      Abatement of the existing house to occur in May
      Construction start is anticipated in June

    Comments (-1)
  • 2022 Q4 Project Updates

    Posted by West Linn - Wilsonville School District on 2/3/2023

    Recent Activities:

    • New School Construction Development phase continues
    • 60% design set being reviewed by the district
    • After consideration of the previous quarters and Post COVID-19 construction material availability/lead times assessment, the decision was made to extend the construction schedule and therefore push the opening of the school to fall 2025
    • Value engineering continues in efforts to bring cost within budget
    • The project was submitted to the City of Wilsonville for Land Use approval in December
    • General contractor pre-qualification proposals were received in December. An evaluation committee has reviewed and will release the qualified bidders list in January 2023



    Upcoming Activities:

    • New School Construction Document Design phase meetings with district stakeholders and consultants continue
    • Continued work with the City of Wilsonville throughout Land Use to achieve approval
    • Project goes out to bid in February for pre-qualified bidders
    • Construction documents will be completed and submitted to the City of Wilsonville for the building permit review and approval
    Comments (-1)

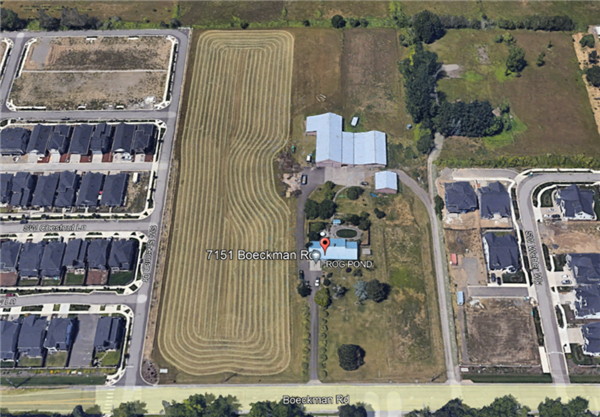

  • Activity at Frog Pond Site

    Posted by West Linn - Wilsonville School District on 1/19/2023

    House

    The District is working with Tualatin Valley Fire and Rescue and the Clackamas County Sheriff’s Office to facilitate training at the existing house on the future site for the new primary school at 7151 SW Boeckman Rd. This house will eventually be demolished and the District is excited to offer this now empty facility for training in which firefighters and police will get to learn how to use new equipment for search and rescue and K9 training. This exercise will take place over the next few months. The community will see multiple fire engine’s and other emergency vehicles on the property and possibly “fake smoke” that they will use to mimic search and rescue efforts in smoke from a fire. These exercises will begin next week, January 23rd.



    If you have any questions, please contact the Project Manager:



    Brooke Besheone

    besheonb@wlwv.k12.or.us

    503-673-7990

    Thank YOU for supporting the Capital Bond and Local Option to make this work possible.

    Be sure to visit the Bond Website to stay informed about projects district-wide.

    Bond Coordinator – Amy Berger

    Comments (-1)
  • New Renderings & Virtual Tour of the New Primary School

    Posted by West Linn - Wilsonville School District on 11/21/2022

    library rendering

    The District has updated the Frequently Asked Questions document for the New Primary School at Frog Pond and added a virtual tour of renderings to the project page on the website. Please visit the project page to see more. https://www.wlwv.k12.or.us/Page/8224



    If you have any questions, please contact the Project Manager:

    Brooke Besheone

    besheonb@wlwv.k12.or.us

    503-673-7990

    Thank YOU for supporting the Capital Bond and Local Option to make this work possible.

    Be sure to visit the Bond Website to stay informed about projects district-wide.

    Capital Bond Coordinator - Amy Berger

    Comments (-1)
  • Contractor Qualifications Phase

    Posted by West Linn - Wilsonville School District on 11/16/2022

    The District has initiated a two-step contractor bid process for the new primary school. This week, general contractors were invited to submit their qualifications to the District for consideration. Qualifications are due mid-December and will be reviewed by a committee including administrators, construction managers, and a designer. In January, the District will announce the list of qualified bidders with the community.

    All contractors interested in obtaining a copy of the request for qualifications should contact Amy Berger at bergera@wlwv.k12.or.us



    If you have any questions, please contact the Project Manager:

    Brooke Besheone

    besheonb@wlwv.k12.or.us

    503-673-7990

    Thank YOU for supporting the Capital Bond and Local Option to make this work possible.
