• Construction Update

    Posted by West Linn - Wilsonville School District on 7/28/2023

    Good afternoon WLWV Community Members,

    We have several updates regarding the New Athey Creek Middle School that we would like to share, including some important reminders.

    NOTICE: The new Athey Creek Middle School site is an active construction zone. Only construction personnel are authorized to enter the property. This restriction is for the safety of all.

    The New Athey Creek Middle School project continues to make steady progress towards completion in time for students this fall. We are excited to open on the first day of school, Aug. 29.

    Classroom

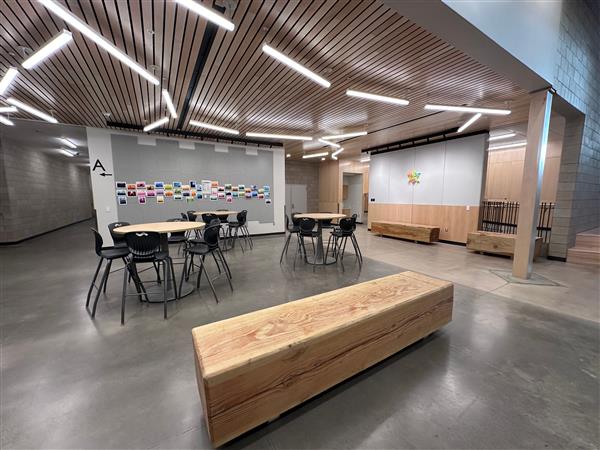

    This picture depicts a typical classroom in the new Athey Creek Middle School. Remaining work includes final ceiling tile, network cable faceplates, tack surface and cleaning. The material on the floor is protection for the carpet. The furniture is assembled and secured in the center of the rooms.

    Aux Gym

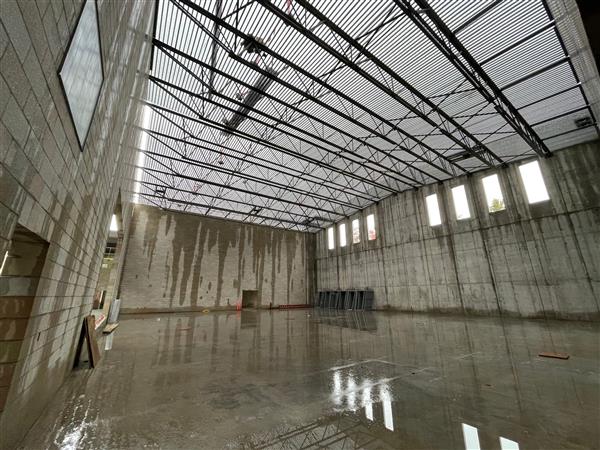

    The auxiliary gymnasium at the new Athey Creek Middle School. Remaining work includes cleaning, wood flooring, power and data outlets. The wood flooring is acclimating in preparation for installation.

    Site Improvements:

    • Irrigation installation is nearing completion, planting is underway
    • Parking lot pavement and striping is complete
    • Concrete sidewalk installation is nearing completion
    • Playground equipment installation is underway
    • Solar panel installation is complete

    Building Improvements:

    • Painting is nearing completion
    • Ceiling installation is nearing completion
    • Lighting installation is nearing completion
    • Mechanical equipment testing is underway
    • Plumbing installation is nearing completion
    • Technology systems installation is underway
    • Flooring installation is underway
    • Window installation is complete
    • Roofing installation is nearing completion
    • Power generator installation is complete
    • Entry vestibules are under construction
    • Casework (cabinetry) installation is nearing completion

    Furniture, Fixtures and Equipment

    • Marker board installation is complete

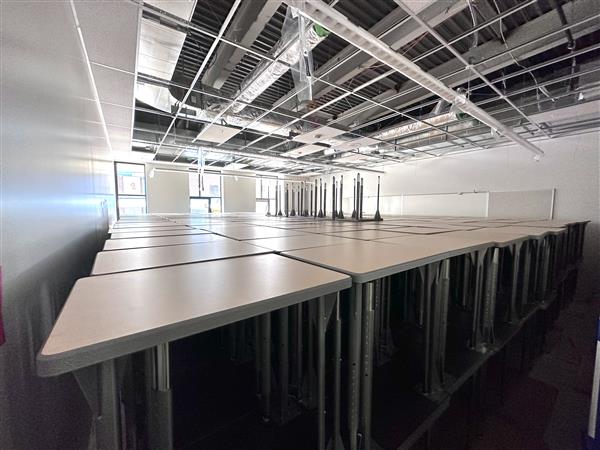

    • Furniture delivery to site is nearing completion
    • Classroom furniture assembly and installation is nearing completion
    • General furniture assembly and installation is underway
    • Equipment and supplies orders have been placed
    • Equipment and supplies deliveries are underway
    • Existing supplies and materials have been moved to storage from prior building
    • Existing supplies and materials delivery to new building is scheduled
    Comments (-1)
  • 2023 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 7/20/2023

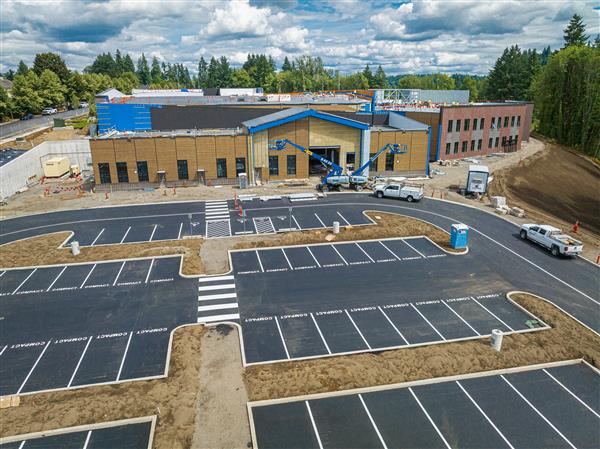

    Parking Lot View

    Recent Activies:
         Permanent power, water and networking are all up and running in the building
         Interior finishes are underway, including acoustic ceiling tiles, light fixtures, painting, tile and casework
         Large kitchen equipment is being installed, including hood, walk in cooler and walk in freezer
         Theater equipment is being installed
         Elevator installation is complete
         Interior doors are being installed
         All Athey items have been moved out of the old building and into trailers until ready to go into the new space
         Final paving was completed on Dollar Street and staff parking lot
         The lower visitor parking lot and new driveway from Brandon Place were installed along with all sidewalks and striping. Parking lot islands are being irrigated and prepped for planting.
         Brandon Place is paved
         Exterior windows are nearly completed with the exception of the entry vestibules
         Solar array panels are installed on the upper level bus canopies
         Exterior light poles have been installed
         Both generators are installed and will begin testing
         The roof is complete and all but one rooftop unit is placed, with completion in late July
         Landscaping has begun and will be ongoing throughout the summer months
         Fence installation has begun
         The concessions building is being constructed

    Upcoming Activities
         Gym flooring is scheduled to start in July
         HVAC installation is expected to be complete at the end of July with testing to follow in August
         Interior glazing will begin in July
         The track and field are being prepared for installation
         The playground equipment will be installed in the coming months

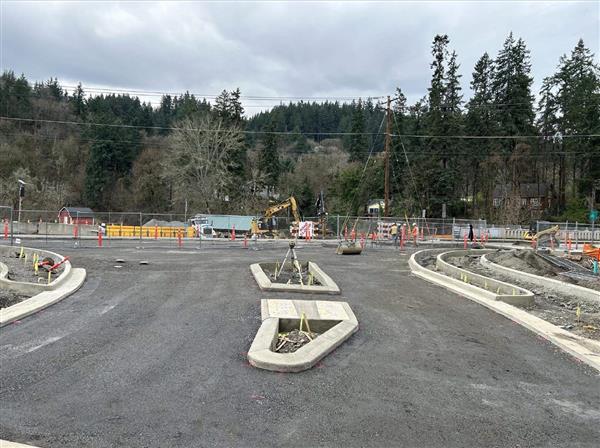

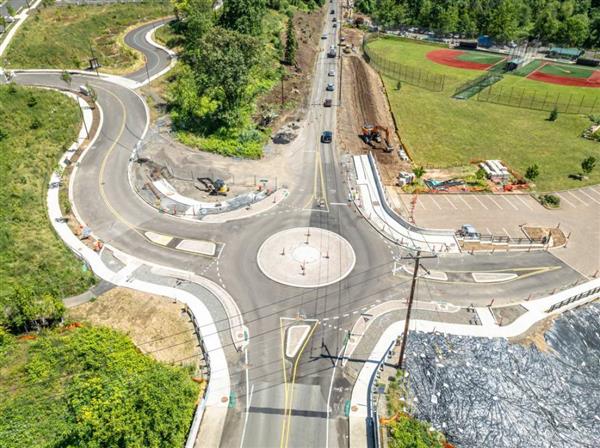

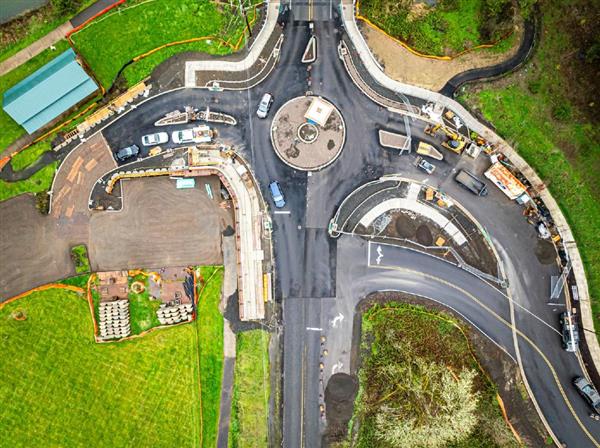

         Reconstruction of the West entry to Fields Bridge Park and construction of the roundabout is pending City of West Linn permitting
         Furniture arrives on site July 17th and will be installed over a three-week period
         Movers will bring Athey Creek staff stored items to the site the first week of August
         Meeting with the City of West Linn to confirm temporary occupancy requirements
         Meeting with TVF&R to outline occupancy requirements
         Temporary entry constructed from Willamette Falls Drive

    Comments (-1)
  • 2023 Q1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/20/2023

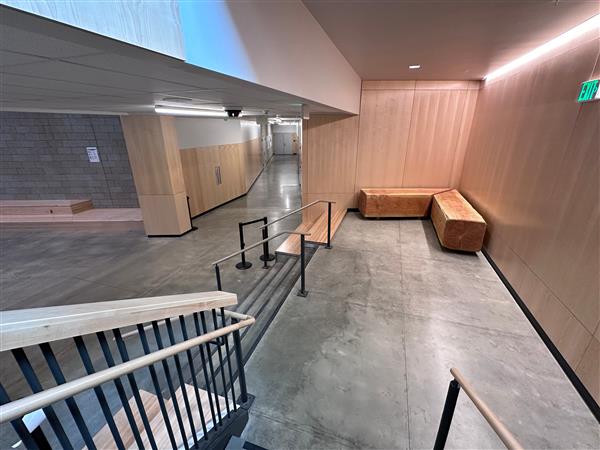

    Interior stairs

    Recent Activities:

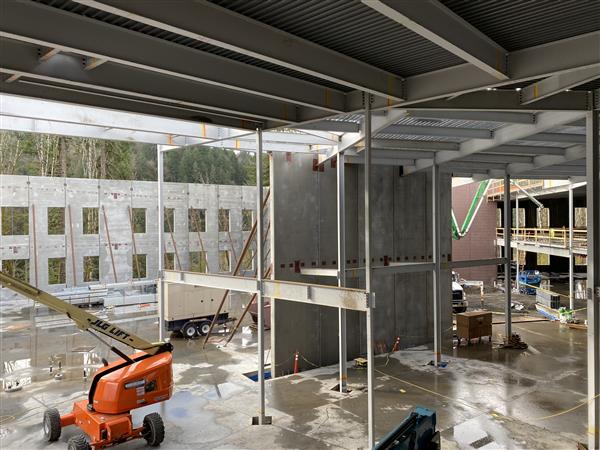

        Structural steel erection is complete, including covered entry areas and bus canopies. Bus canopies will be finalized with translucent solar panels in the spring.
        Interior metal stud framing is nearly complete, with drywall installation beginning in selected areas.
        The temporary roof has been completed, with the exception of the large expansion joint area between the commons and classroom wings. Final roof installation is occurring as weather permits.
        Major plumbing, HVAC and Electrical components are being installed, including electrical switchgear, boilers, terminal units and rooftop mechanical units.
        Exterior window frame installation is in progress and will frame the main entry to the building.
        The City of West Linn has assigned the new address: 2110 Brandon Place.
        Water line installation on Willamette Falls DRive is complete and retaining wall installation on the north side of Willamette Falls DRive is in progress.
        New curbs are installed on the new Brandon Place extension, and the intersection of Brandon Place and Dollar Street is being prepared for final asphalt.
        The moving company was hired and Athey CReek staff have begun packing for the move this summer.
        Elevator installation has begun

    Upcoming Activities:
        Final paving on Dollar Street was delayed due to weather but is anticipated to occur in April.

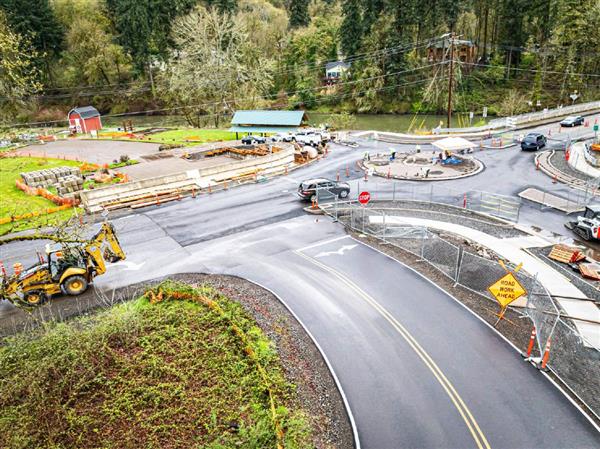

        Reconstruction of the West entry to Fields Bridge Park and continued work on the north side of Willamette Falls Drive, including new street lights, bike paths, and sidewalks
        Interior finish work will commence in the building this spring, including drywall, casework, tiling and paint.
        Parking lots and track work to commence later in the spring.
        Permanent power will be installed to the building in April.

    Comments (-1)
  • Athey Creek at Dollar Project Update : Paving of Dollar Street

    Posted by West Linn - Wilsonville School District on 4/12/2023

    With a break in the weather and dry weather expected the rest of week, paving of Dollar Street will take place this Thursday and Friday (April 13-14). Flaggers will provide street access for neighbors and will maintain traffic on Dollar Street. Delays are to be expected during this work.

    The City will provide digital signage to alert traffic of work.

    Comments (-1)
  • New Athey Creek Middle School Construction Update

    Posted by West Linn - Wilsonville School District on 3/20/2023

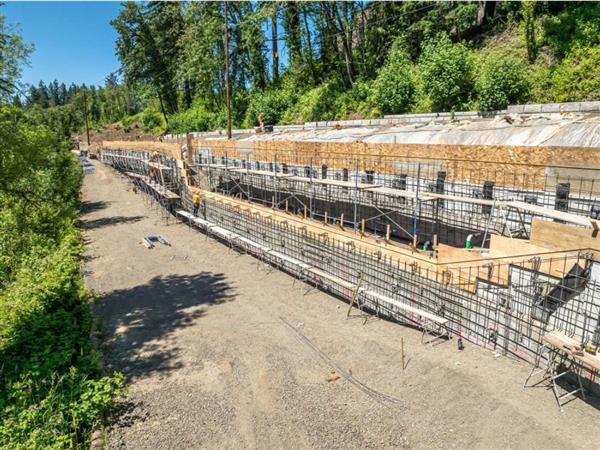

    The installation of the underground water line on Willamette Falls Drive is complete. The crew will continue to work on the North side of Willamette Falls Drive near Epperly Way in preparation for underground utilities, as well as new retaining walls. Traffic control measures will continue on Willamette Falls Drive for the next couple of weeks as these areas are being worked on.

    The General Contractor is also preparing to install the final layer of asphalt on Dollar Street.  There will be flaggers present to direct traffic once this work commences. The exact dates that this work will take place are dependent on the weather. The City has moved one of the digital traffic signs to Dollar Street to advise neighbors of upcoming traffic limitations.

    Comments (-1)
  • New Athey Creek Middle School at Dollar Street Project Update 2-17-2023

    Posted by West Linn - Wilsonville School District on 2/17/2023
    Attached is a project update for the New Athey Creek Middle School Bond Project including project pictures.

    Construction on the North side of Willamette Falls will begin Monday, Feb. 20. Key information includes:
    • The utility contractor will be installing an underground waterline along Willamette Falls Drive.
    • Flaggers will assist traffic flow, with priority being given to any emergency vehicles.
    • This work is part of the district's permit which was approved in 2021.
    • Permitted work along Willamette Falls Drive will be conducted with City coordination, and the public will be informed ahead of time.
    The interior construction of the building is progressing steadily. Items currently being installed are as follows:
    • Main staircase at the upper entry is installed as well as other steel stairs throughout the building.
    • Temporary roof membrane is competed.
    • Rooftop air handling units are being installed.
    • Drywall installation has commenced.
    • Mechanical and electrical rough-in is ongoing.

    New Athey Creek Middle School Listserv Update 2-17-2023

    Comments (-1)
  • 2022 Q4 Project Updates

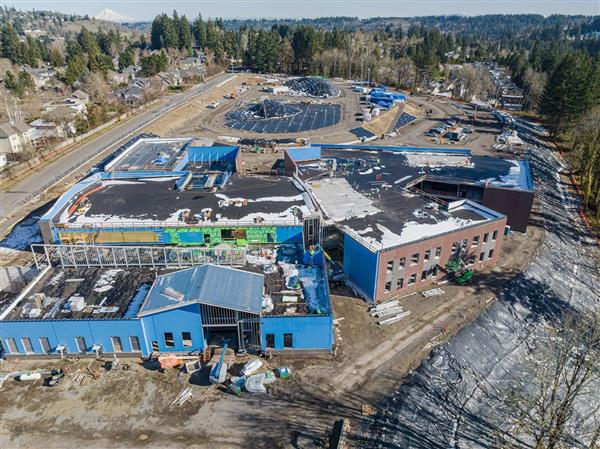

    Posted by West Linn - Wilsonville School District on 2/3/2023

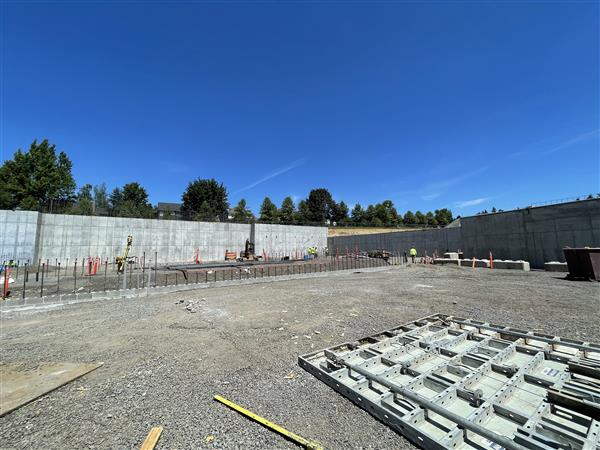

    New Athey Creek Exterior

    Recent Activities:

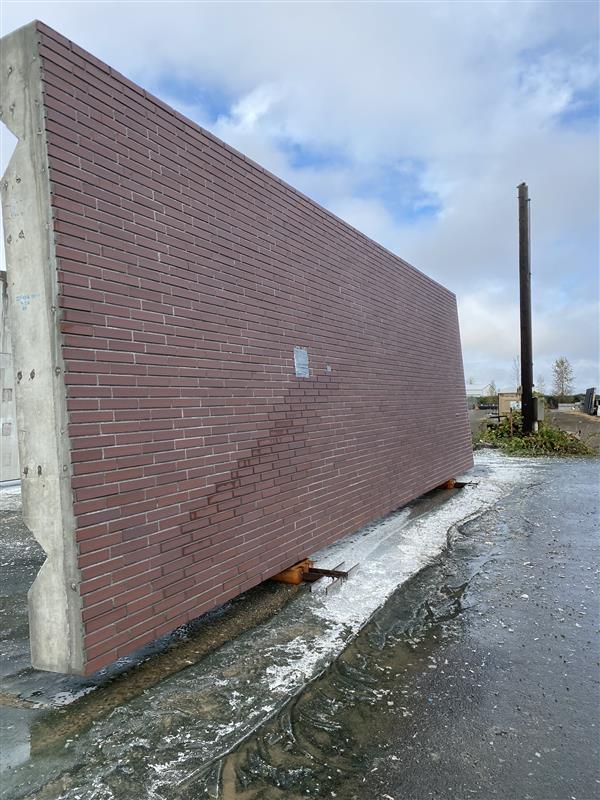

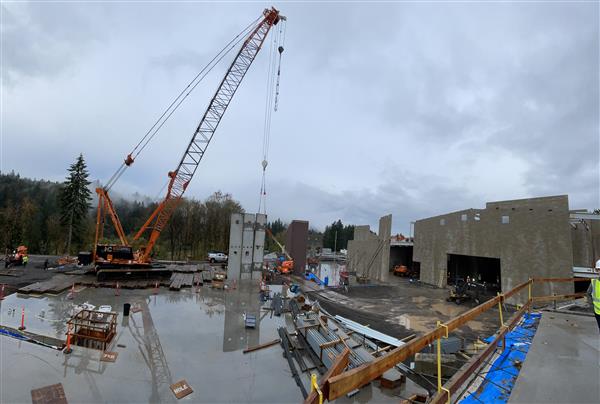

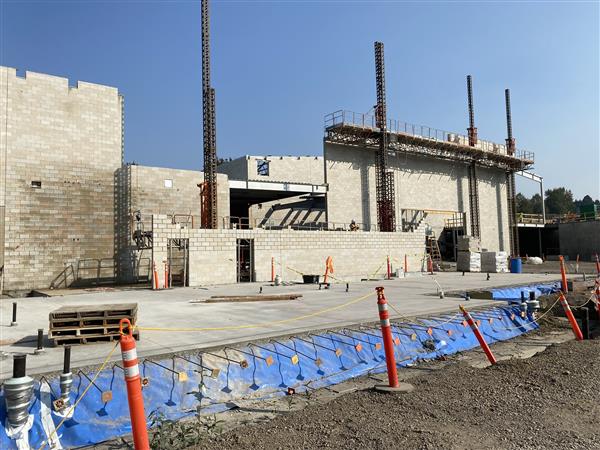

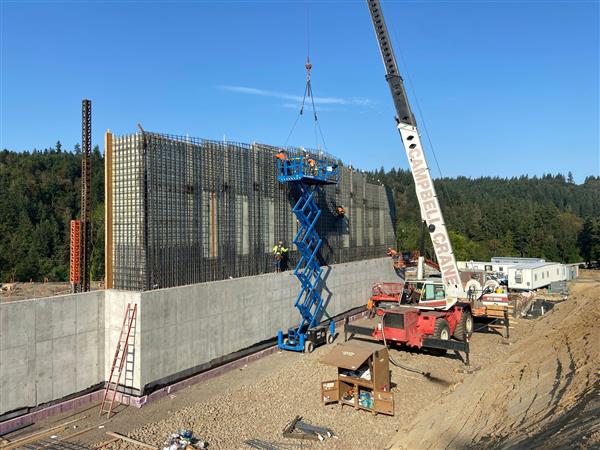

    • Precast wall installation began in October and was complete in 11 days
    • Structural steel and steel decking installation is continuing
    • The interior steel studs are being installed and interior walls are defined for the band room, choir, stage, locker rooms and other specialty spaces
    • Installation of the temporary roof system is complete on approximately 50% of the building
    • Plumbing and electrical rough in is being complete to allow drywall installation in the dried in areas
    • Window measurements have been confirmed with delivery expected in February
    • The track has been defined and is currently used as a staging area for equipment and supplies before being completed
    • A furniture order was placed and is scheduled for delivery this summer
    • Street improvements on Dollar St. were completed in November. Final lift will be complete with offsite work this spring.
    • Sidewalks on the north side of Dollar St. are complete. South sidewalks are being worked on and remain closed.
    • Work on Brandon Place has commenced

    Upcoming Activities:

    • Drywall in sectors A and B
    • Major equipment delivery - Electrical Switchgear for power to the building
    • Work on Willamette Falls Drive
    • Classroom framing will begin in January
    • Moving companies will turn in bids in January for the move of supplies and select furniture/equipment from the existing Athey Creek to the new school
    Comments (-1)
  • Project Updates

    Posted by West Linn - Wilsonville School District on 12/2/2022

    Good afternoon WLWV Community,

    We have multiple project updates to share. Exterior walls of the new school were recently installed in addition to several accompanying components. Interested community members are encouraged to watch this project update video with more details.

    The contractor also recently erected the sports field lighting at the new Athey Creek Middle School. These fixtures have become a regular feature of modern athletic fields and will support school and community use of the track and field as darkness comes early for much of the year. The modern LED lighting is energy efficient and the fixtures have a high degree of control over the spread of light. The same technology is currently in use at West Linn High School, Wilsonville High School and Wood Middle School. The lights are permitted for use until 10 PM.
    Comments (-1)
  • New Athey Creek Middle School Update Video

    Posted by West Linn - Wilsonville School District on 11/28/2022

    Big things are happening at the construction site for our new Athey Creek Middle School. See the crews are putting up walls and keeping the project on schedule for welcoming students in the fall of 2023.

    Comments (-1)
  • New Athey Creek Middle School Street Work

    Posted by West Linn - Wilsonville School District on 10/27/2022

    Asphalt paving on Dollar Street is schedule to commence during the week of October 31, 2022. All work will occur during normal working hours, but the exact start date is dependent on weather. One through lane of traffic will remain open for the majority of this work. There will likely be a small window of work that will require traffic to detour. The district is working with the City of West Linn to incorporate signage to keep the public informed of construction activities.

    Comments (-1)
