• 2022 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 7/22/2022

    19034.011 – Renovation at Wood Middle School
    Recent Activities:
    ■ Digital street sign installed
    ■ Final punchlist work is nearing completion, all construction fencing has been removed and the building has
    been turned over to the school

    Upcoming Activities:
    ■ Final payment and closeout

    19053.017 – Roofing at Boeckman Creek Primary School
    Project Status:
    This project is on hold.

    19054.017 – Fire Sprinklers at Boeckman Creek Primary School
    Project Status:
    This project includes fire sprinkler main line replacement at Boeckman Creek Primary School.
    This project was bid and awarded to Brockamp & Jaeger Inc. Work started in late June after school was released for the summer. Work will continue through the summer and be done before the start of school. No material delays are expected as part of this project.

    19057.009 – Recabling Project at Boeckman Creek and Stafford Primary Schools
    Project Status:
    This project includes recabling to update to CAT 6 and 6A at both Boeckman Creek and Stafford Primary Schools.
    This project was bid and awarded to Brockamp & Jaeger Inc. Work started in late June after school was released for the summer. Work will continue through the summer and be done before the start of school. No material delays are expected as part of this project.

    Comments (-1)
  • 2022 Q1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/28/2022

    Renovation at Wood Middle School

    Recent Activities:
    ■ Bathroom additions and concession stand work nearly complete
    ■ Playground area open for student use

    Upcoming Activities:
    ■ Complete addition
    ■ Finish commissioning of mechanical equipment

    Fire Sprinklers at Boeckman Creek Park Primary School

    Project Status:
    This project includes fire sprinkler main line replacement at Boeckman Creek Primary School.
    This project is currently out to bid.

    Comments (-1)
  • 2021 Q4 Project Updates

    Posted by West Linn - Wilsonville School District on 1/21/2022

    – Renovation at Wood Middle School

    Recent Activities:

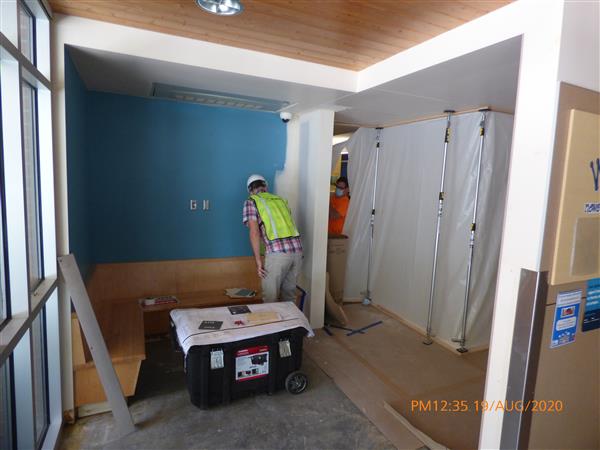

    ■ Office staff moved into newly constructed office space

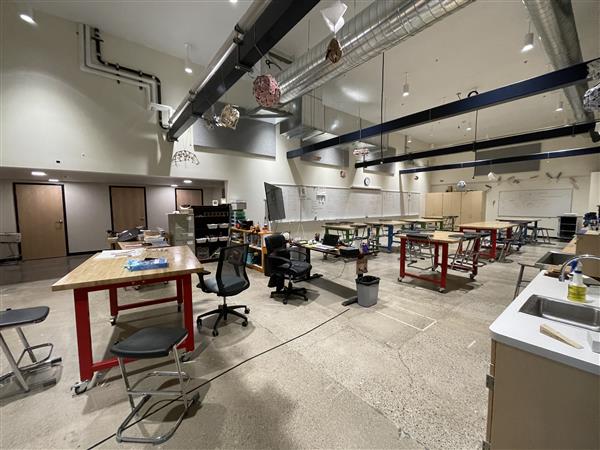

    ■ New Makerspace is complete and in use
    ■ Addition is underway

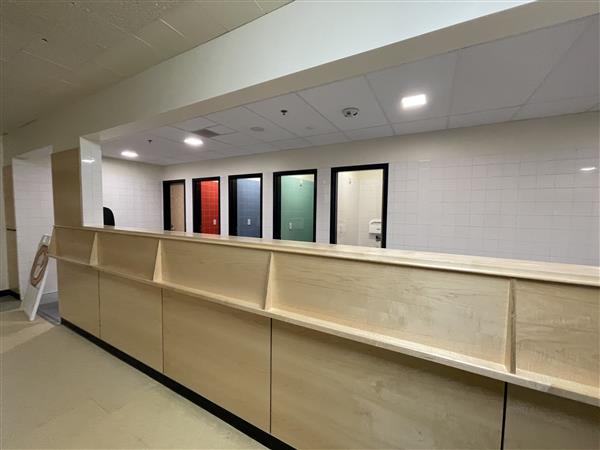

    ■ New single occupant gender neutral restrooms are complete

    Upcoming Activities:
    ■ Complete addition
    ■ Finish punchlist in the main building

    Wood Bathrooms

    19049.009 – Renovations at Stafford Primary School & Willamette Primary School

    Project Status:This project is complete

    19050.009 – Renovations at Bolton Primary School and Cedaroak Park Primary School
    Project Status: This project is complete

    19053.017 – Roofing at Boeckman Creek Primary School
    Project Status: This project includes a complete roof replacement at Boeckman Creek Primary School.
    This project design is underway.

    19054.017 – Fire Sprinklers at Boeckman Creek Park Primary School
    Project Status: This project includes a complete fire sprinkler system replacement at Boeckman Creek Primary School.
    This project design is underway.

    Comments (-1)
  • 2021 Q3 Project Updates

    Posted by West Linn - Wilsonville School District on 10/21/2021

    19034.011 – Renovation at Wood Middle School
    Recent Activities:
    ■ Classrooms opened
    ■ Boilers are operating
    ■ Office, makerspace and restrooms in process

    Upcoming Activities:
    ■ Take occupancy of the office in November
    ■ Complete addition
    ■ Complete Greenhouse

    new office exterior construction

    19049.009 – Renovations at Stafford Primary School & Willamette Primary School
    Project Status:
    Stafford has had all HVAC work completed and functioning, commissioning is underway, and the contractor is working on closeout items. At Willamette the storm drain along 12th Street is complete, classroom ventilators are installed and the front entry concrete is complete and railing has been installed.

    19050.009 – Renovations at Bolton Primary School and Cedaroak Park Primary School
    Project Status:
    Bolton currently has temporary ventilation, cooling and heating installed at some classrooms while the contractor waits for the delayed HVAC units. The units that have arrived have been installed and the contractor is working on punchlist items. Cedaroak Park has all mechanical equipment installed and functioning and the exterior painting is underway.

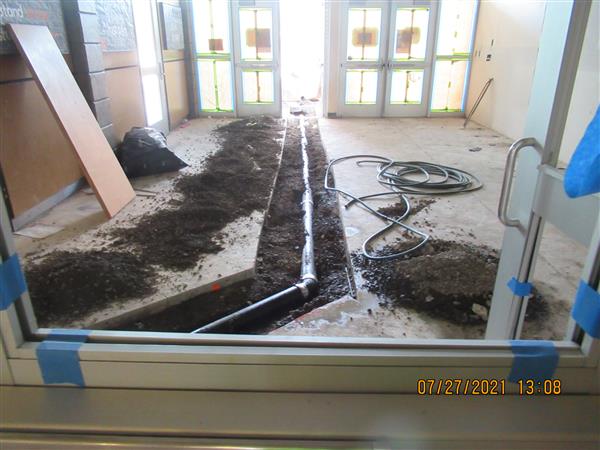

    Willamette EntryWillamette's new ADA ramp and entry

    Comments (-1)
  • 2021 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 8/4/2021

    19034.011 – Renovation at Wood Middle School
    Project Status:
    Light renovation through various parts of the school, total renovation of front classroom cluster, relocation of office and creation of maker space and a restroom/concessions building addition. Design includes security upgrades, energy efficiency improvements, and the life cycle replacement of mechanical and fire alarm systems.

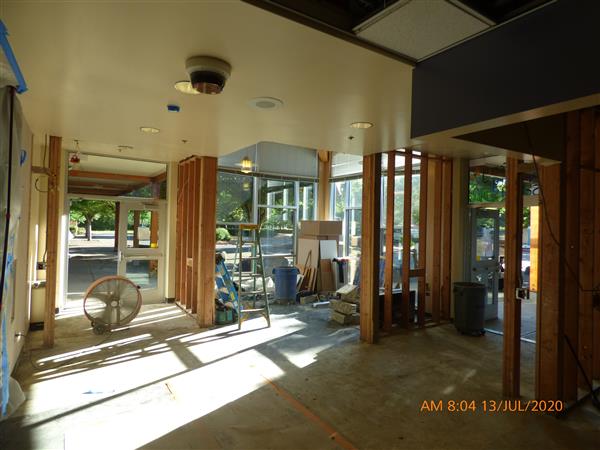

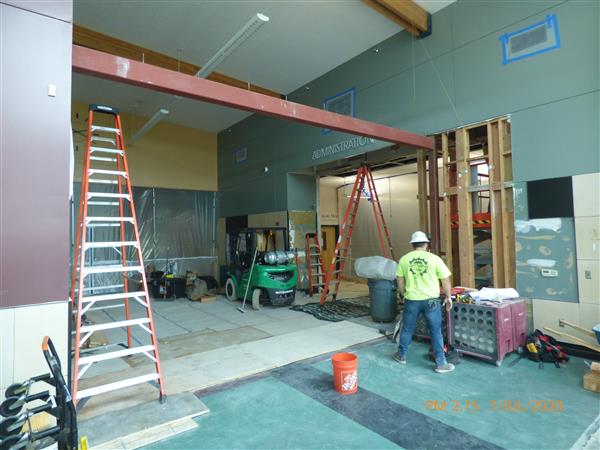

    Inza Wood Interior

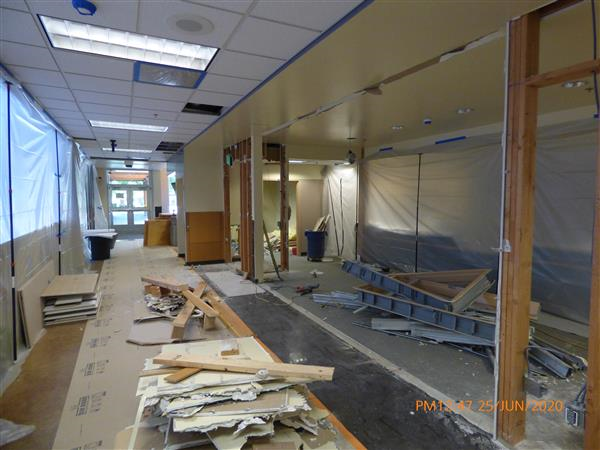

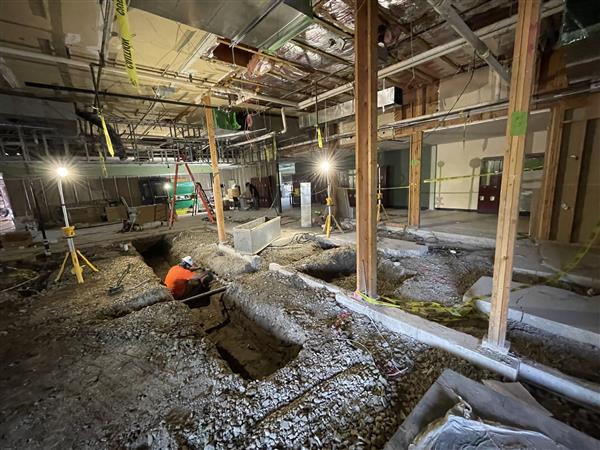

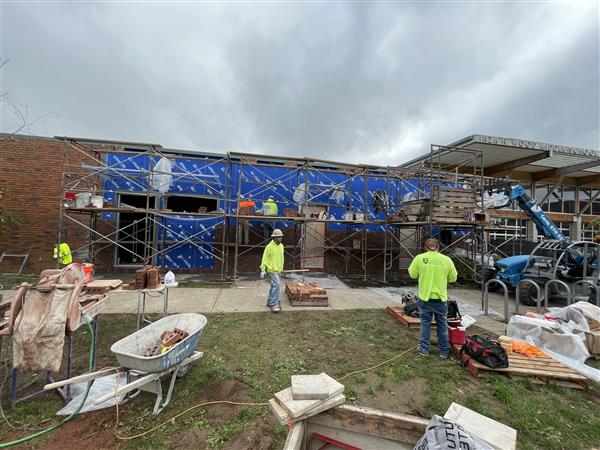

    Contractor mobilization began early, utilizing after school hours. Contractor has focused attention on all interior school scope of work to ensure readiness for students return in the fall. Areas currently being demolished include the old administration offices and classrooms on the Northeast side of the building. Classrooms on the Southwest side of the building have been demolished and are in plumbing, mechanical, and structure phases. Roof work above the main gym is in process including removing the old mechanical units and constructing a new roof diaphragm. Excavation is underway for the new restroom and concession addition as well as the new greenhouse.

    19049.009 – Renovations at Stafford Primary School & Willamette Primary School
    Project Status:

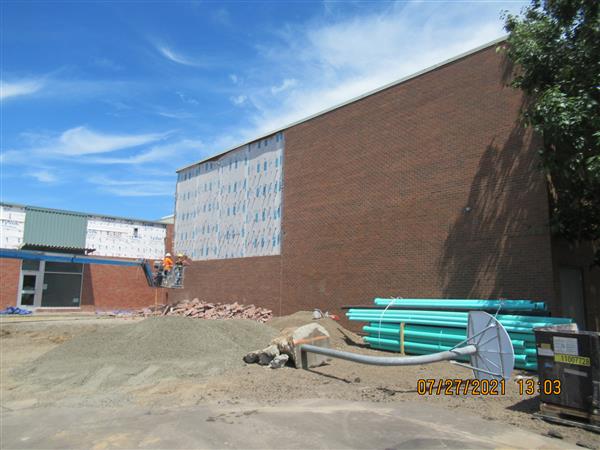

    Construction began at the end of June. Recent work at Stafford includes abatement at the kitchen, demolition for HVAC above classroom spaces and electrical and carpentry working on new rooftop units. At Willamette work at the front entry has begun as well as HVAC, controls and electrical demo inside. Storm drain work along 12th Street is underway.

    Willamette Entry

    19050.009 – Renovations at Bolton Primary School and Cedaroak Park Primary School
    Project Status:
    Construction began at the end of June. Recent work at Bolton includes electrical and HVAC demo as well as rough in carpentry for both upper and lower classrooms. Cedaroak exterior painting has begun and ductwork cleaning, water heater demo and plumbing getting underway.

    Comments (-1)
  • 2021 Quarter 1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/22/2021

    19034.011 – Renovation at Wood Middle School
    Project Status:

    Project has been advertised and awarded. Contractor mobilization is expected spring 2021. Logistics planning to ensure separation of construction and school activities underway.
    ■ Low bid below budget and estimate
    ■ Board authorized selection of all project scope

    19049.009 – Renovations at Stafford Primary School & Willamette Primary School
    Project Status:
    The project was bid and a general contractor was awarded the project in February. The low bid was over budget but near the estimate. The School Board authorized selection of the base bid. This project is scheduled to start construction this summer.

    19050.009 – Renovations at Bolton Primary School and Cedaroak Park Primary School
    Project Status:
    The project was bid and a general contractor was awarded the project in February. The low bid was over budget but near the estimate. The School Board authorized selection of the base bid. This project is scheduled to start construction this summer.

    Comments (-1)
  • Quarter 4 Project Updates

    Posted by West Linn - Wilsonville School District on 2/2/2021

    19034.011 – Renovation at Wood Middle School
    Project Status: Light renovation through various parts of the school, total renovation of front classroom cluster, relocation of office and creation of maker space and a restroom/concessions building addition. Design includes security upgrades, energy efficiency improvements, and the life cycle replacement of mechanical and fire alarm systems.

    Project design has been completed and will go out for bid January 2021. Anticipated contract award February 2021 with construction activities planned during summer and fall 2021. Logistics planning to ensure separation of construction and school activities underway.

     Wood Entry Rendering

    19042.019 Sports Field Relighting at Wilsonville High School
    Project Status: Project is complete.

    19044.009 – Security @ COP, RR, ST
    Project Status: This project includes security upgrades at these three schools. The work has been designed, bid and the work is underway. The work is substantially complete.

    19045.009 – Security @ BF, LW
    Project Status: This project includes security upgrades at these two schools. The work has been designed, bid and the work is underway. The work is substantially complete.

    Stafford Entry

    19048.009 – Renovations at Bolton Primary School and Cedaroak Park Primary School
    Project Status: This project includes classroom air conditioning, security improvements and other life cycle replacement work. Project will go out to bid late January with construction scheduled over summer 2021.

    19049.009 – Renovations at Stafford Primary School and Willamette Primary School
    Project Status: This project includes classroom air conditioning, security improvements and other life cycle replacement work. Also includes a new accessible and secure entry for Willamette Primary School. Project will go out to bid late January with construction scheduled over summer 2021.

    Willamette Primary Rendering

    Comments (-1)
  • Quarter 3 Project Updates

    Posted by West Linn - Wilsonville School District on 10/28/2020

    Renovation at Inza Wood Middle School

    Project Status: The project is scheduled for construction summer and fall 2021. It is currently in the Design Development phase and is being reviewed by district leadership.

    Sports Field Relighting at Wilsonville High School

    Project Status: The onsite work is complete and closeout documentation is underway.

    WHS lighting at night

    Track Replacement at Athey Creek Middle School

    Project status: Project is complete

    Security @ Boones Ferry and Lowrie Primary Schools

    Project Status: This project has been designed, bid, and the work is underway and substantially complete.

    Security @ Cedaroak Park Primary, Rosemont Ridge Middle and Stafford Primary Schools

    Project Status: This project has been designed, bid, and the work is underway and substantially complete.

    Rosemont entry

    Flooring at Stafford

    Project Status: This project is complete

    Mechanical at West Linn High and Willamette Primary Schools

    Project Status: This project is complete

    Renovations @ Bolton and Cedaroak Park Primary Schools

    Project Status: This project includes classroom air conditioning, security improvements and other life cycle replacement work. Design is currently underway with an expected construction start summer 2021.

    Renovations at Stafford and Willamette Primary Schools

    Project Status: This project includes classroom air conditioning, security improvements and other life cycle replacement work. Design is currently underway with an expected construction start summer 2021.

    Comments (-1)

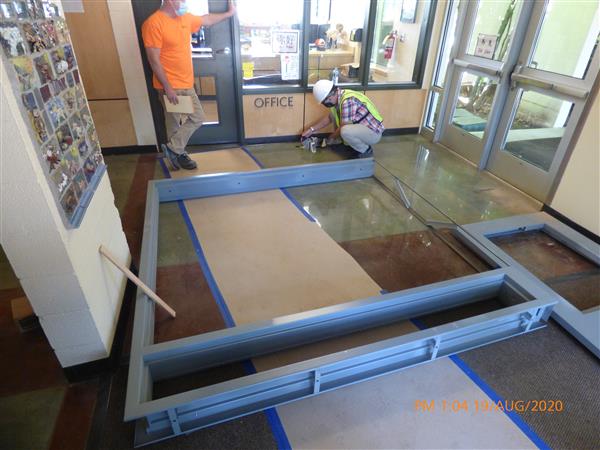

  • Improvements at Inza R. Wood Middle School

    Posted by West Linn - Wilsonville School District on 9/25/2020 10:25:00 AM

    Design and planning are steadily progressing for renovations at Wood Middle School. Improvements will include security upgrades, a new CTE (career and technical education) makerspace classroom, LED lighting improvements, gym roof replacement, mechanical system replacements and a restroom/concessions building addition. Design Completion is anticipated for November 2020, with construction beginning Summer 2021.

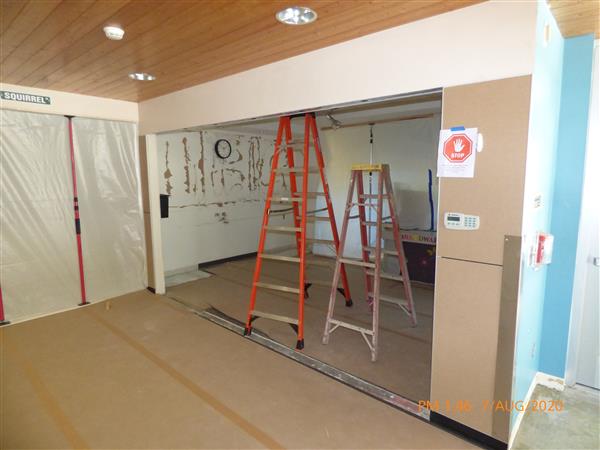

    Exterior Wood Entry

    Comments (-1)
  • Summer 2020 Mechanical Upgrades

    Posted by West Linn - Wilsonville School District on 9/25/2020 10:00:00 AM

    Boiler Replacement at WLHS

    This summer, replacement occurred of an existing boiler at West Linn H.S. that had previously been in failure. Tied into the building’s automated control system, the new boiler will provide reliability and increased energy efficiency.

    RTU Replacement at Willamette Primary

    This summer, replacement occurred for one existing gas-fired makeup air unit on top of the Willamette Primary Gymnasium.
