- Project Updates

-
2023 Q1 Project Updates
Posted by West Linn - Wilsonville School District on 4/20/2023Recent Activities:

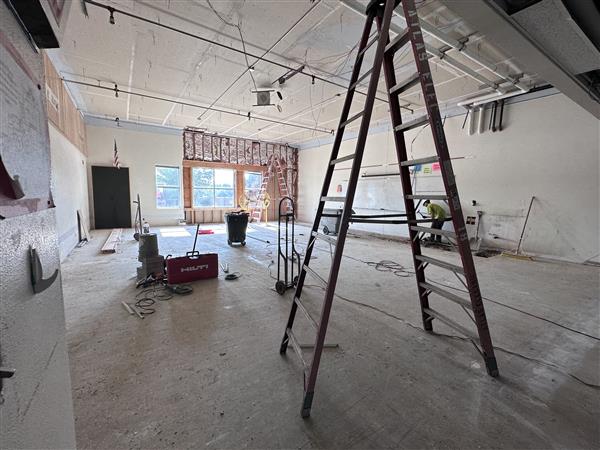

■ Office remodel punchlist work is 99% complete
■ The renovation for summer 2323 work to convert spaces to the new high school has been bid and a contract has been awarded.

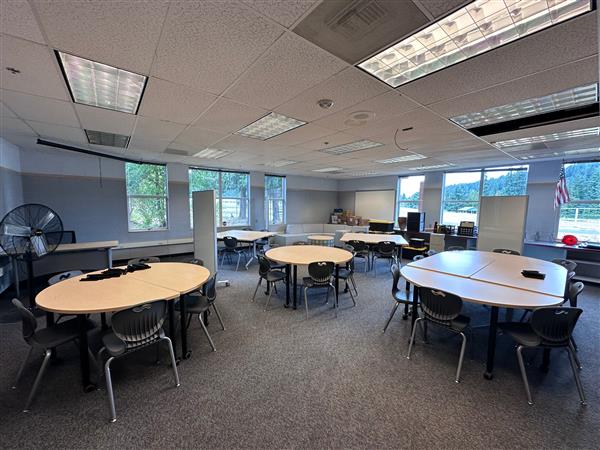

■ Partial furniture orders placed for the new high school spacesUpcoming Activities:
■ Office remodel final punchlist items to be complete
■ Empty current athy Creek Middle School and begin renovation summer 2023 for the school fall 2023.

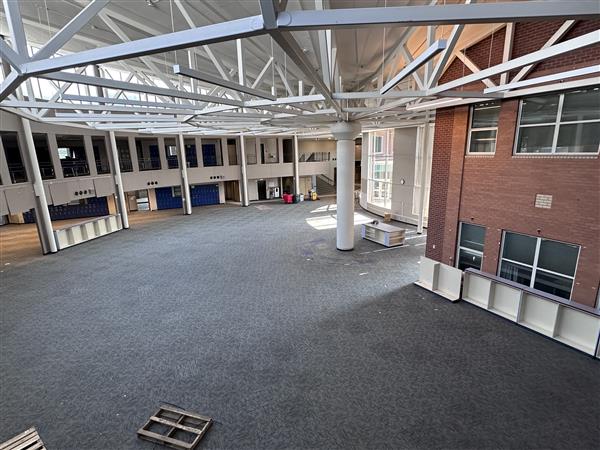

■ Continue to order equipment, furniture and supplies for Riverside High School. -
2022 Q4 Project Updates
Posted by West Linn - Wilsonville School District on 2/3/2023Recent Activities:
- Office remodel punchlist work is 99% complete
- The renovation for Summer 2023 work to convert spaces to the new high school has been bid and a contract has been awarded
- Furniture orders placed for new high school spaces
Upcoming Activities:
- Office remodel final punchlist items to be complete
- Empty current Athey Creek Middle School and begin renovation Summer 2023 for school fall 2023
- Continue to order furniture and supplies for Riverside High School
-
2022 Q3 Project Updates
Posted by West Linn - Wilsonville School District on 10/26/2022Recent Activities:

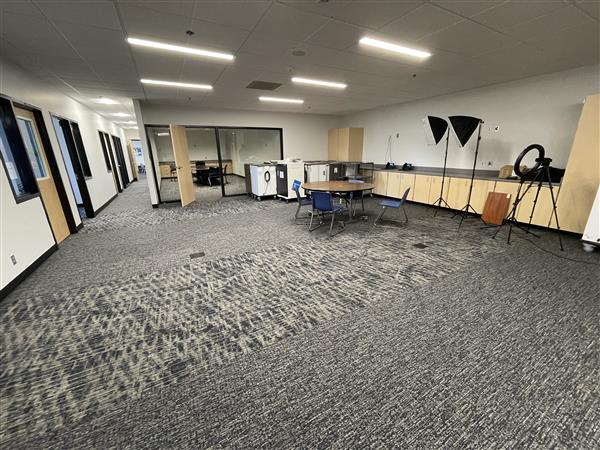

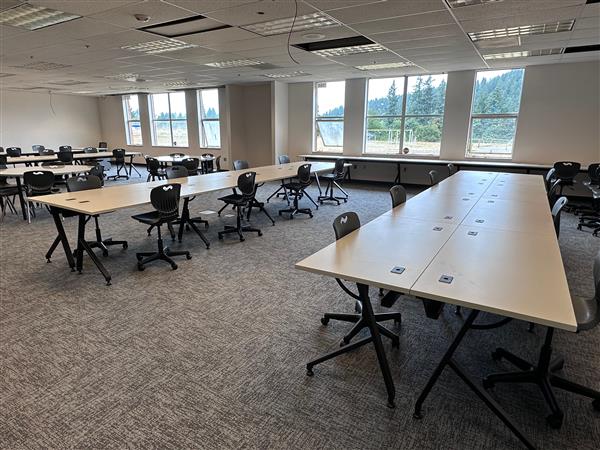

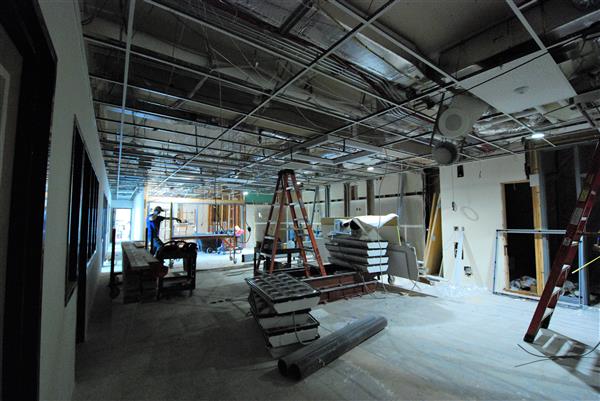

■ Existing office space renovation is substantially complete.
■ Punch list progress
■ Design for Summer 2023 phaseUpcoming Activities:
■ Complete design for Summer 2023 phase
■ Bid Summer 2023 phase this fall
■ Order furniture and supplies for Riverside High School -
Bond Construction Update: Riverside High School
Posted by West Linn - Wilsonville School District on 8/3/2022See the latest work turning Athey Creek Middle School into the new Riverside High School and how the new classrooms are being built while not interrupting the learning of our middle school students.
-
2022 Q2 Project Updates
Posted by West Linn - Wilsonville School District on 7/22/2022Recent Activities:

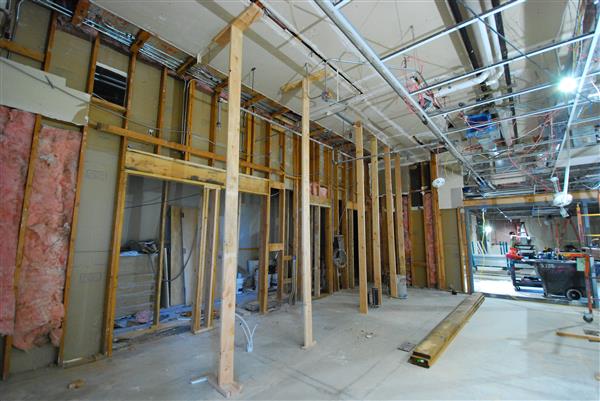

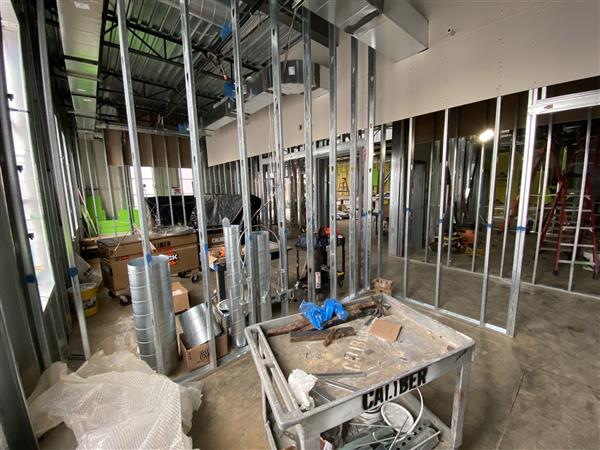

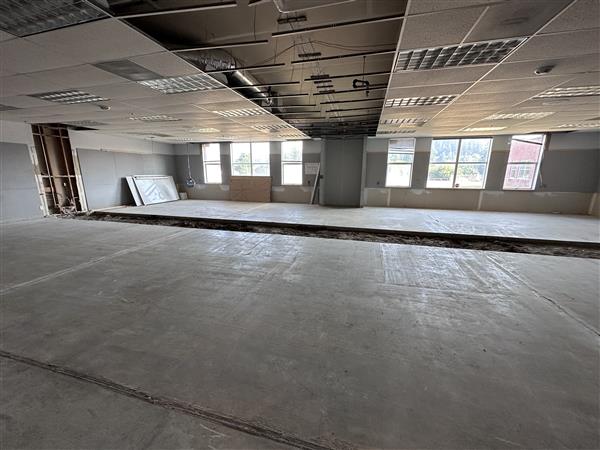

■ Existing office space demolition is complete
■ Currently framing in single occupant restrooms and conference rooms
■ Mechanical, Electrical and Plumbing rough-in work has begun in the existing office space
■ Science hall roof well work has begun
■ Additional roof work and building envelope nearing completion

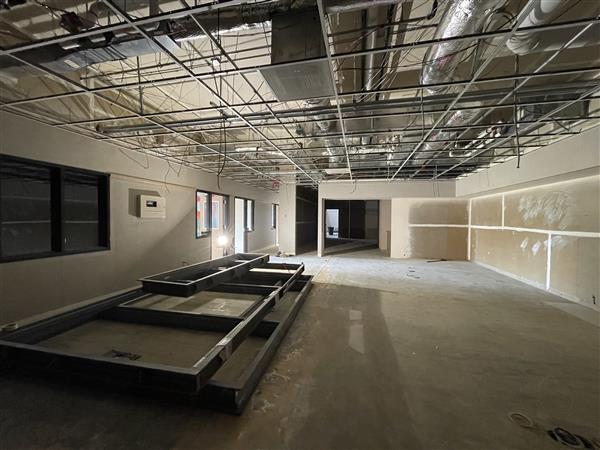

■ Punch list work has begun on new office space
Upcoming Activities:
■ Substantial completion of current construction is expected at the
end of August 2022
■ Design for final phase of work, scheduled for construction
summer of 2023 -
2022 Q1 Project Updates
Posted by West Linn - Wilsonville School District on 4/28/2022Recent Activities:
■ Staff has moved into the new office space
■ Commissioning of the mechanical systems is underway

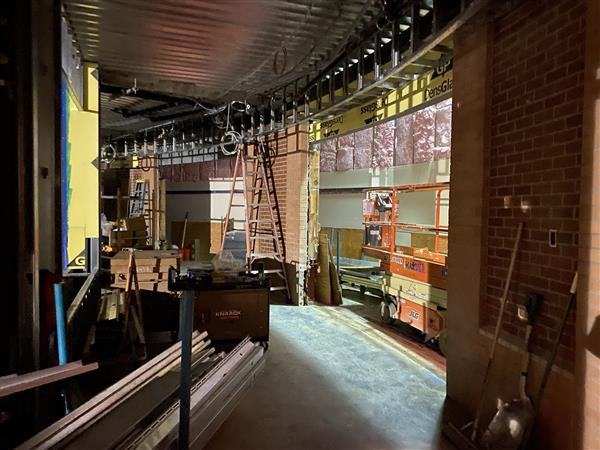

■ Existing office space demolition work is underway

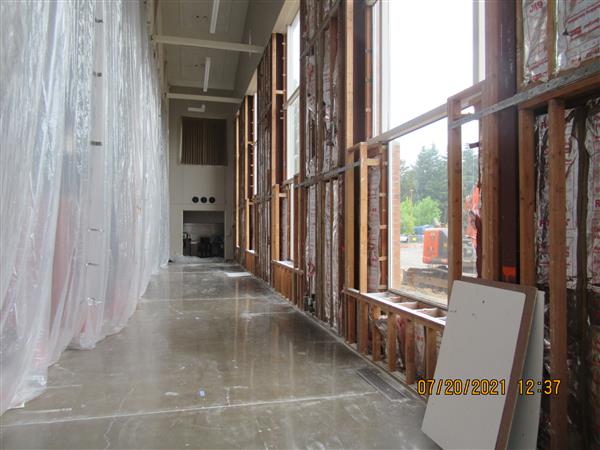

■ Concrete tile roof replacement is nearing completion
Upcoming Activities:
■ Steel package installation for new mechanical unit over existing office space
■ Completion of interior finishes

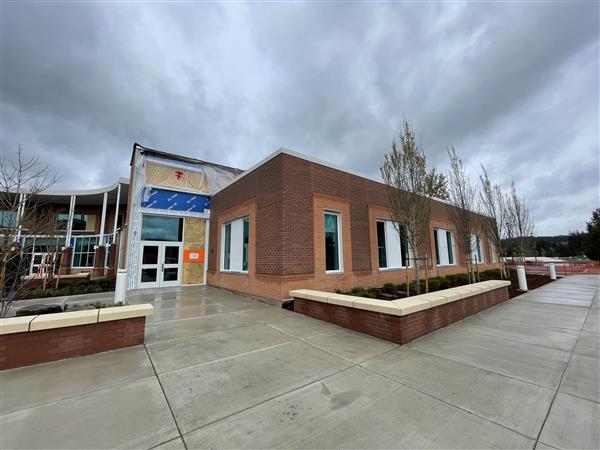

■ Vestibule glass installation
■ Continued work in the existing office space -
School Board Selects Riverside High School as Name for District's Third High School
Posted by West Linn-Wilsonville on 3/15/2022 9:00:00 AMDuring a special March 21 School Board Meeting, the West Linn-Wilsonville School Board officially selected Riverside as the name of the District's third option high school following a thorough community engagement process. The Board selected Riverside High School for several reasons, including:
- Riverside has geographical significance and highlights the school's proximity to the Willamette, Tualatin, and Clackamas Rivers.
- Riverside is distinct and unique among high schools in Oregon.
- Riverside is meaningful to both the West Linn and Wilsonville communities, uniting both with this new school that will draw students from all over the district.

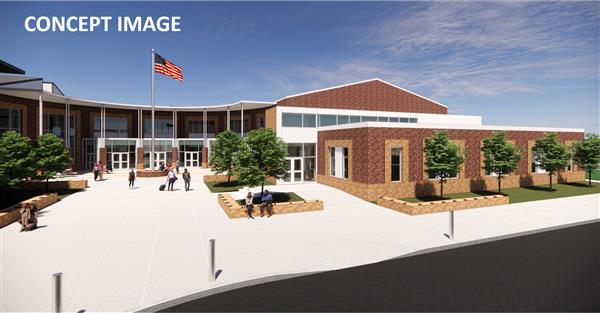

Riverside High School will officially open for the 2023-24 school year. It will be located at the current Athey Creek Middle School site following capital bond improvements. The current Athey Creek Middle School will be relocated to the Dollar Street site where construction of a new middle school is currently underway.
To follow bond project progress, interested community members are encouraged to visit the bond website and sign up for bond updates.
-
2021 Q4 Project Updates
Posted by West Linn - Wilsonville School District on 1/21/2022Recent Activities:

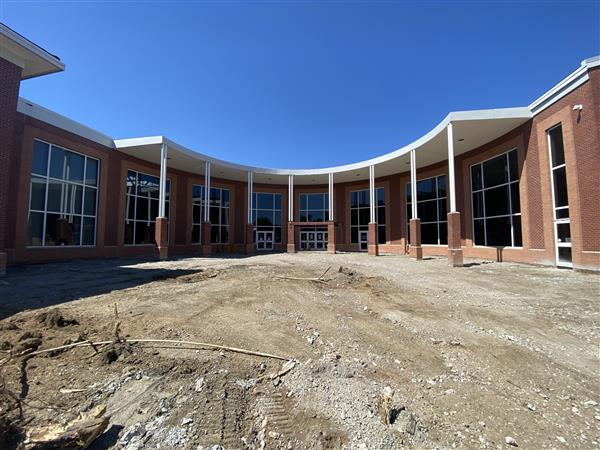

■ New Addition roof is complete
■ Brick facade nearing completion

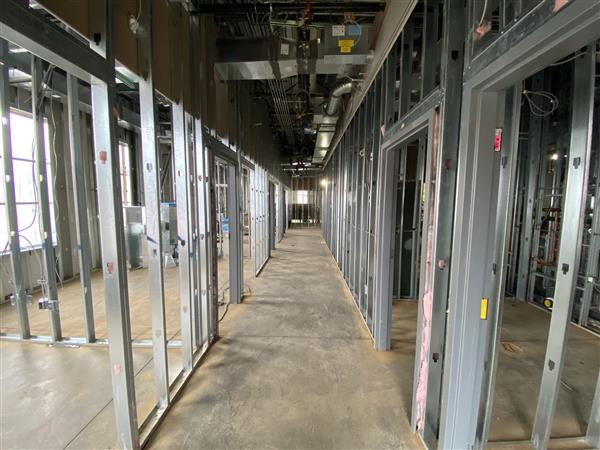

■ Interior walls are framed, covered and ready for paint
■ Well system shutdown, cleaning and inspection and control system upgrades occurred
Upcoming Activities:

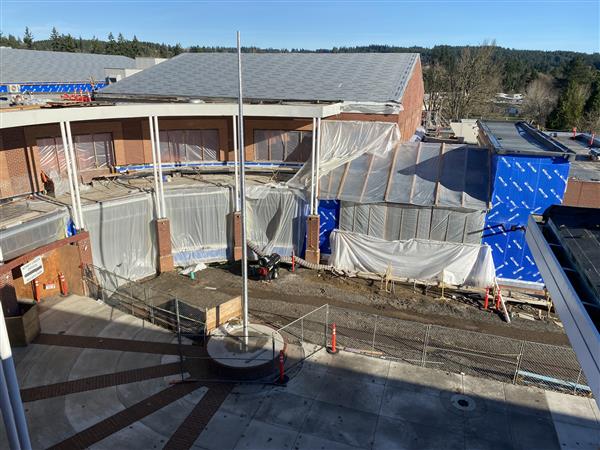

■ Existing slope roof work continues
■ Completion of interior finishes
■ Furniture installation
■ Renovation of existing office space starting up Spring 2022 -
Third High School Project Update
Posted by West Linn - Wilsonville School District on 11/18/2021ACMS Office Addition Project

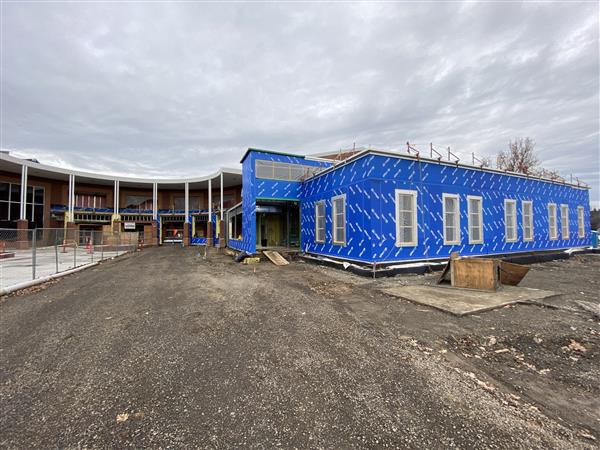

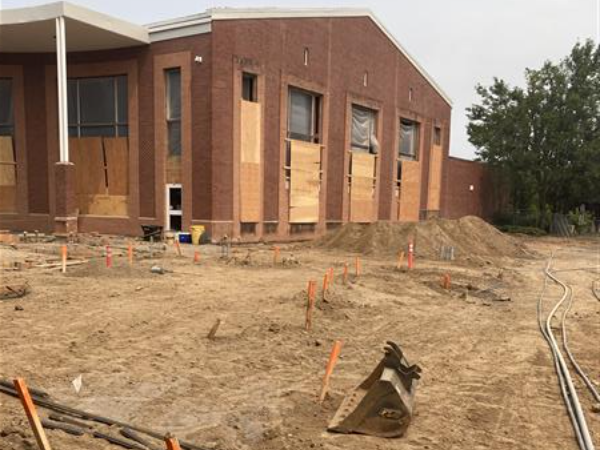

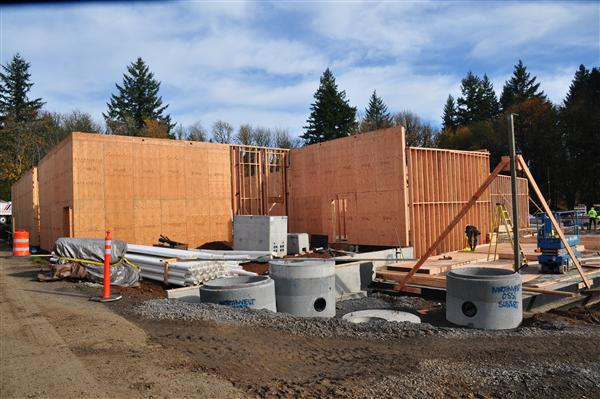

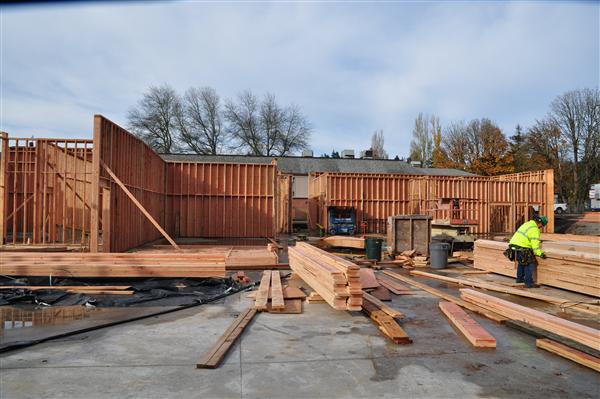

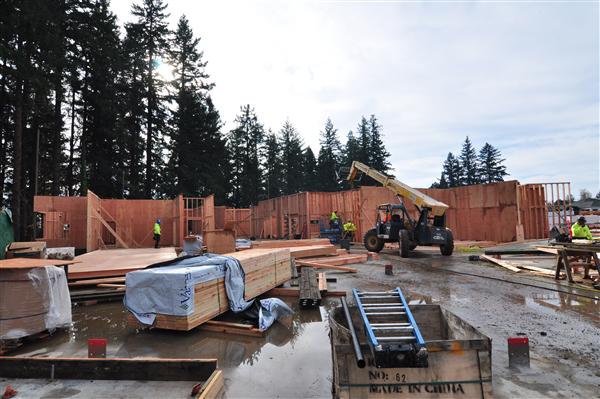

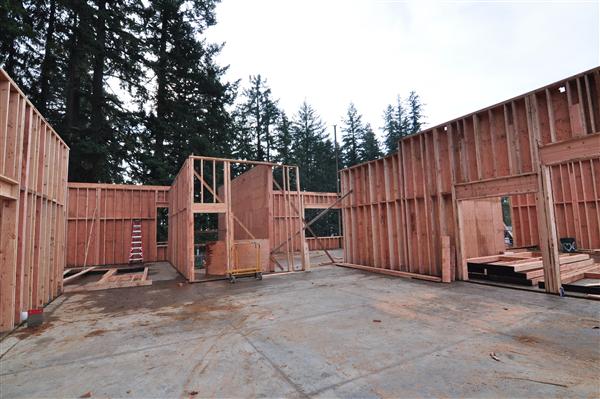

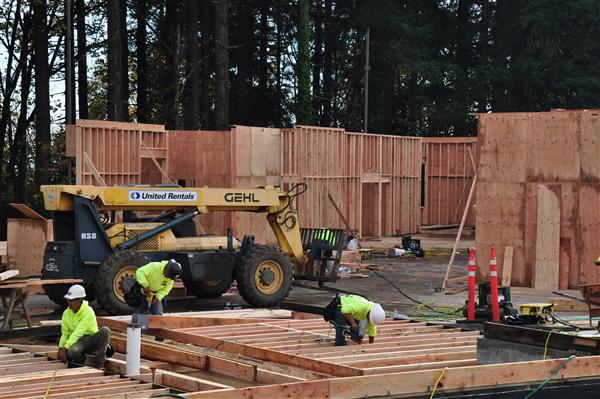

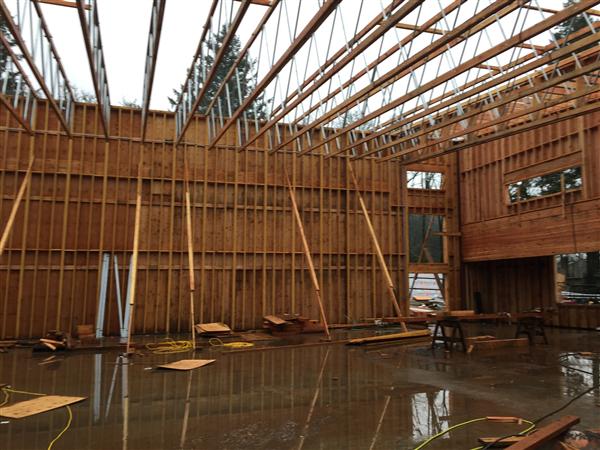

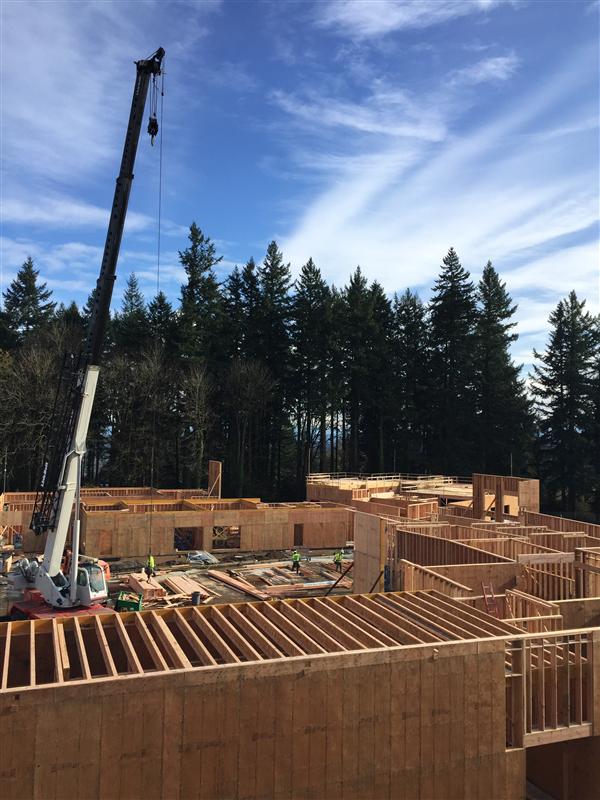

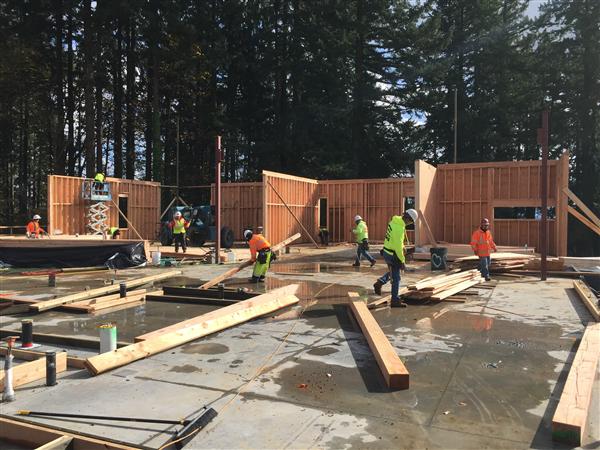

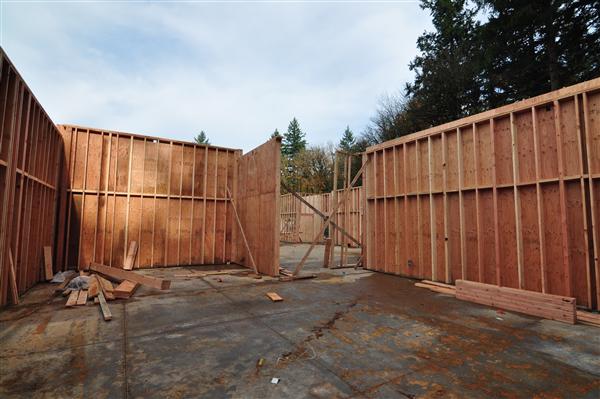

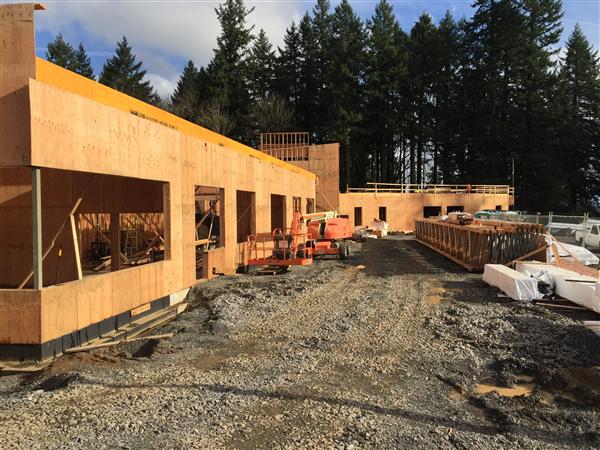

The contractor continues with the office addition phase of construction targeting Winter break for completion. The Office and new entry are taking shape, with exterior walls being completed and roofing material arriving on site. Installation of electrical, mechanical and plumbing systems are also underway.

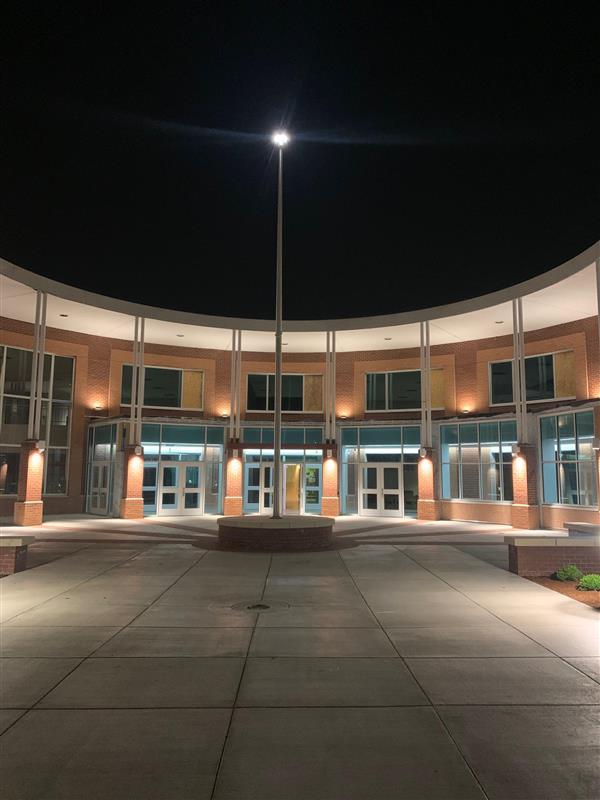

Temporary lighting was provided while parking lot work continues, and the new parking lot poles are now set. Once this scope of work is completed the project will transition from the temporary light poles to the new lighting.
The sidewalk expansion work for the parent drop-off area is nearing completion and is expected to be available in the coming weeks.
During the course of this project the district is taking advantage of opportunities to upgrade existing systems in preparation for the school’s transition to the new third option High School. Over Thanksgiving break the school is expected to be re-keyed. This will include the new classroom lockdown hardware. The plumbing system updates are expected to be completed over the Winter break. During this time the School will not have running water but will be back up and running before students return in January. Also during the Winter break the new generator is expected to be installed in the new enclosure and be fully functional before students return.
Once the school staff has successfully moved into the new office, phase 2 of the project will begin. This phase will transform the old office spaces into the new student services center for the new Third Option High School.
Phase 1 is expected to wrap up over Winter break, while Phase 2 is expected to start early 2022 and wrap up spring 2022.
Questions can be directed to the Project Manager: Ryan Hendricks hendricr@wlwv.k12.or.us
-
2021 Q3 Project Updates
Posted by West Linn - Wilsonville School District on 10/21/2021Recent Activities:
■ New MDF and IDF is complete
■ Data rewire is approximately 70% complete, with the remainder to take place during phase 2 of the project

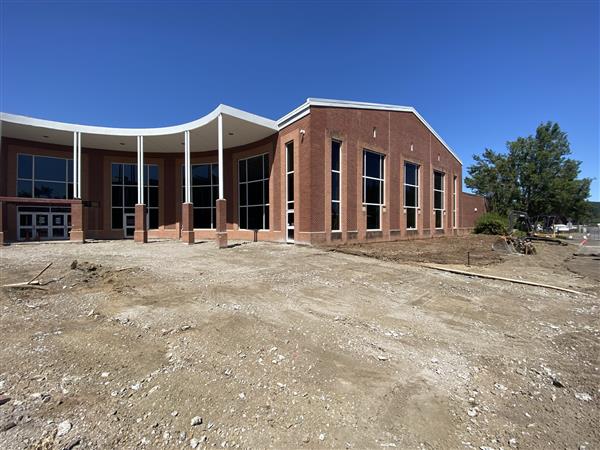

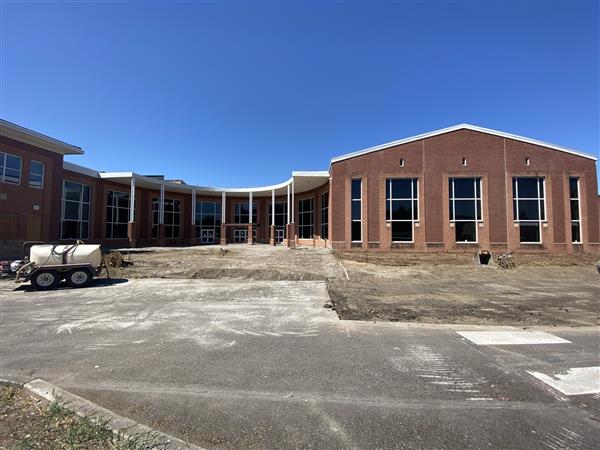

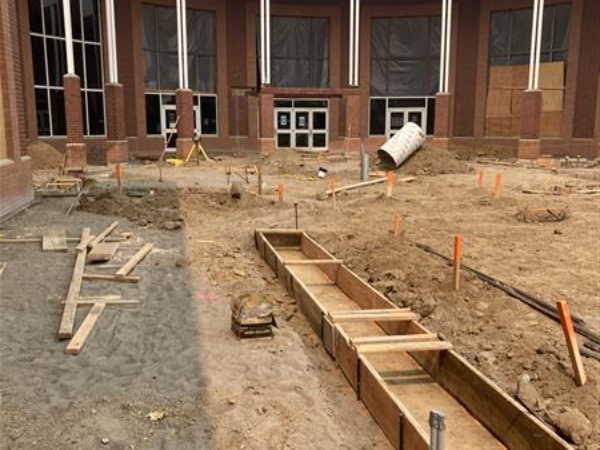

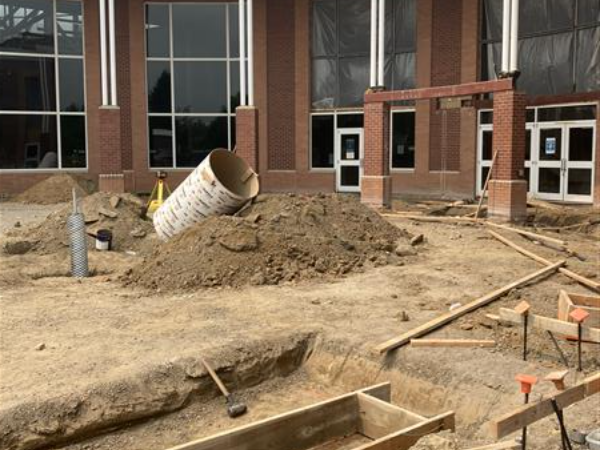

■ New front entry plaza has begun construction, temporary access provided for school

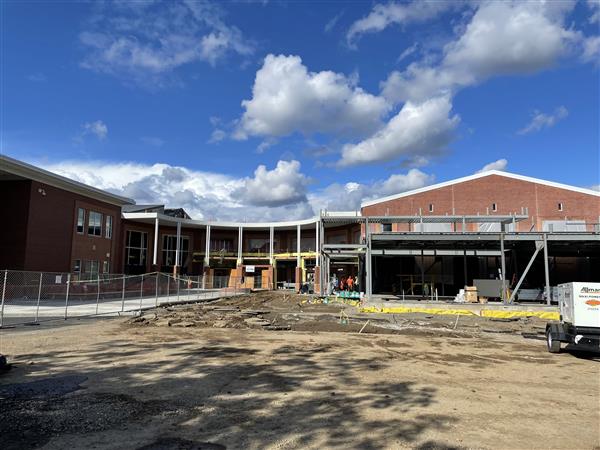

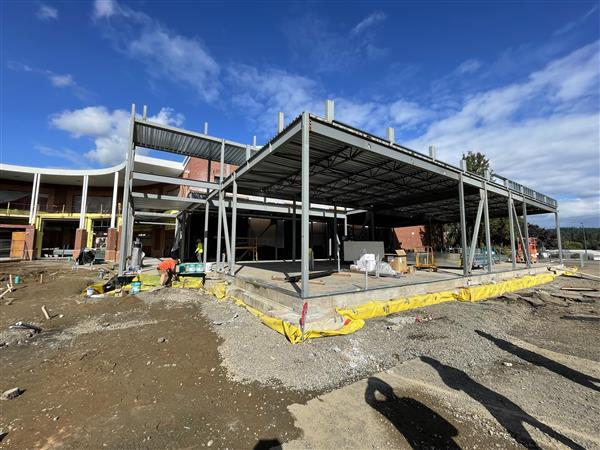

■ All structural steel on the new entry is complete and framing walls is underwayUpcoming Activities:
■ Rough in for Mechanical, Electrical, and Plumbing to occur late October
■ Roof installation
■ Air handling unit replacement during Thanksgiving break
■ Well system shutdown, cleaning and inspection and control system upgrades during Winter break
