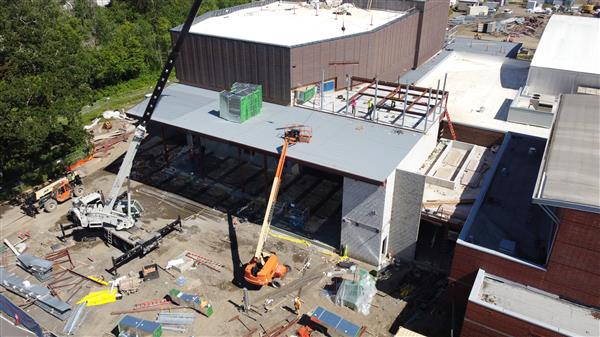

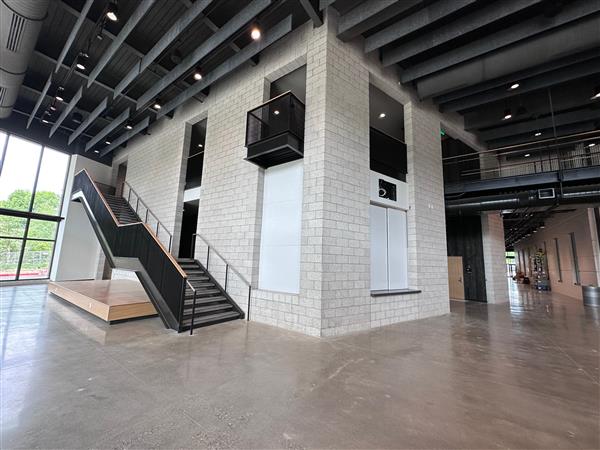

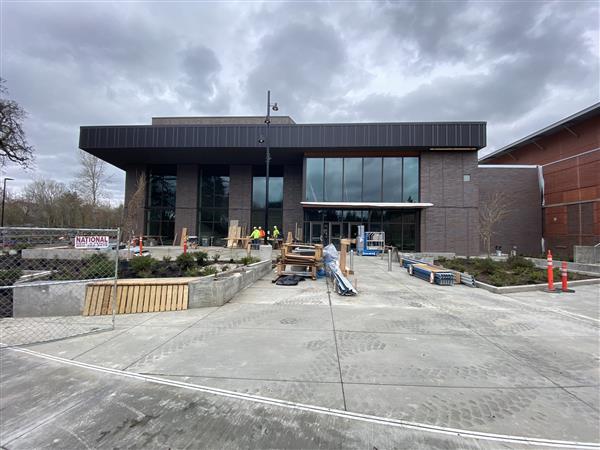

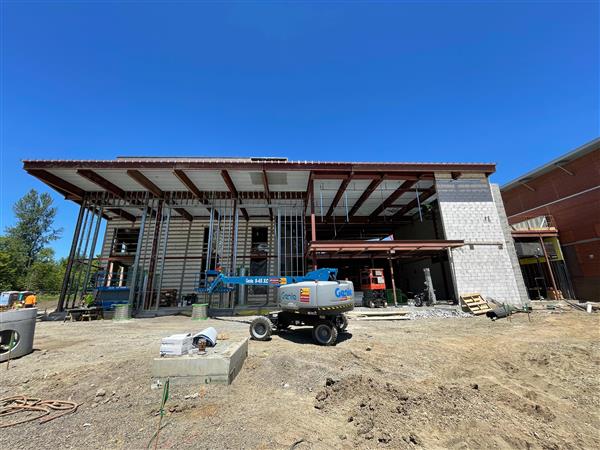

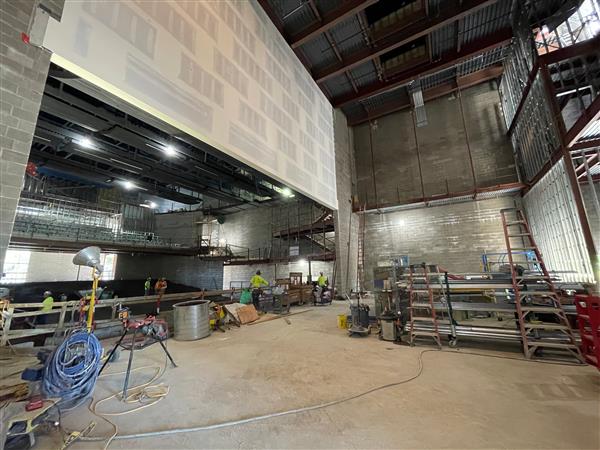

• 2022 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 7/22/2022

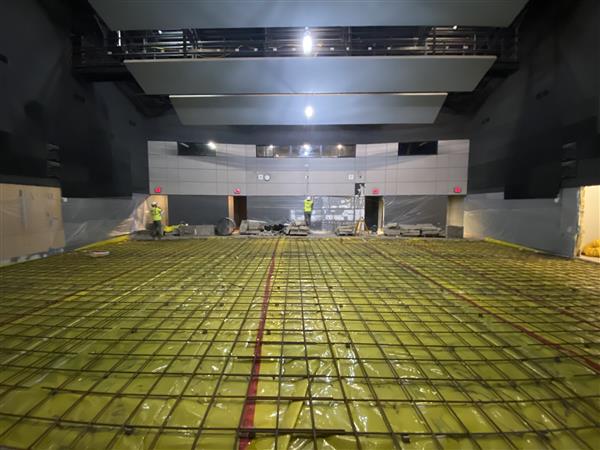

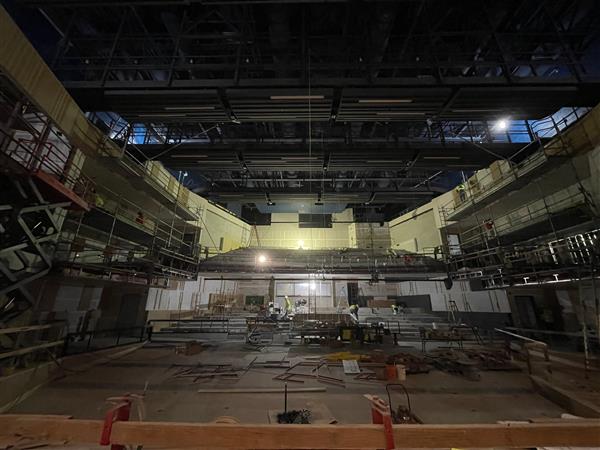

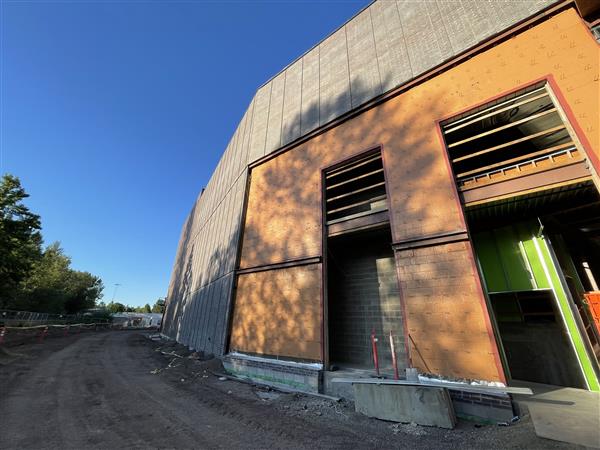

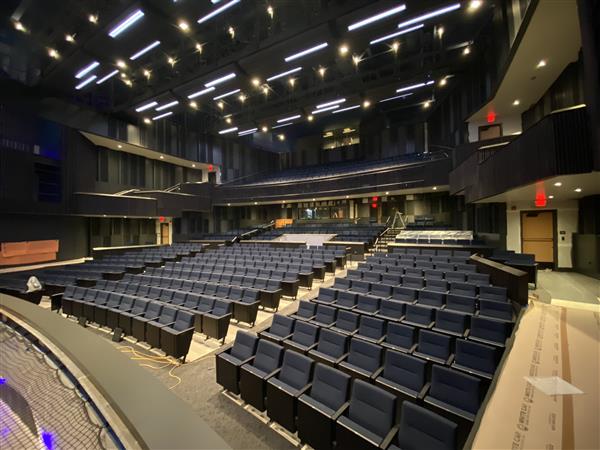

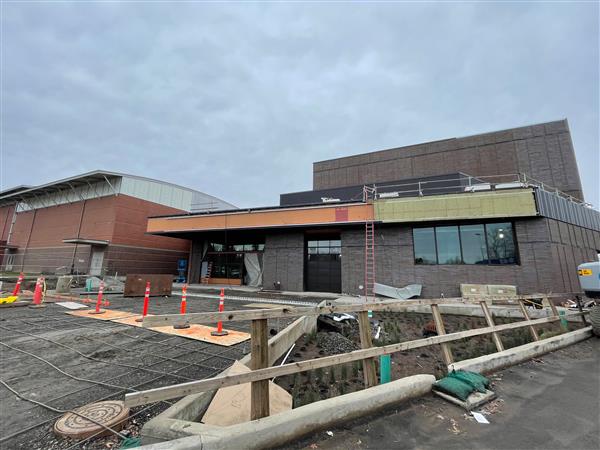

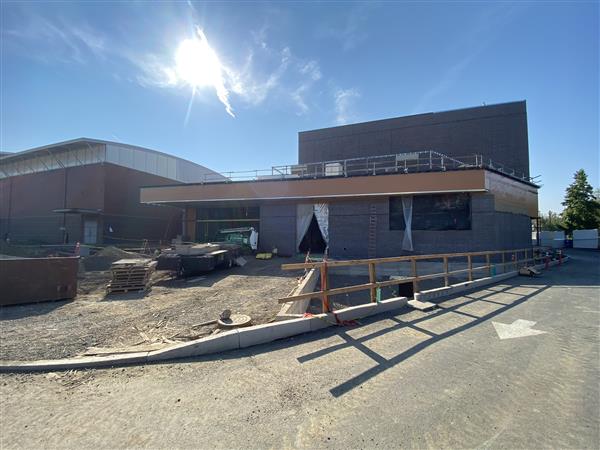

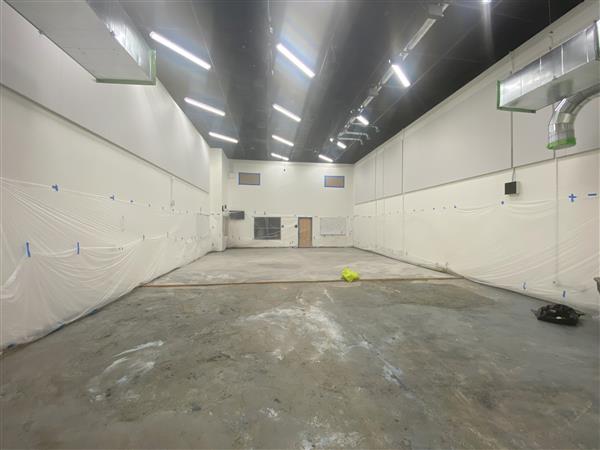

    Auditorium Exterior

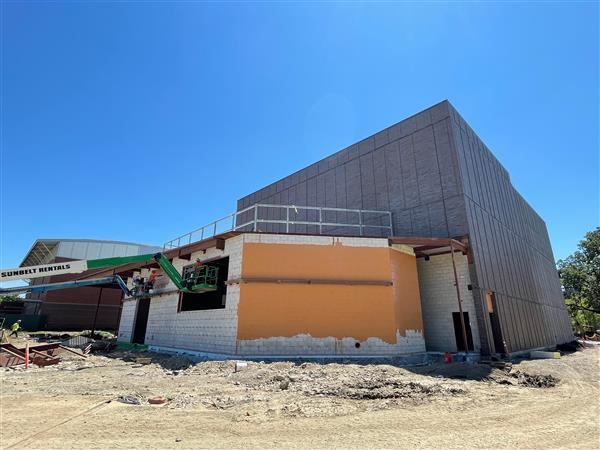

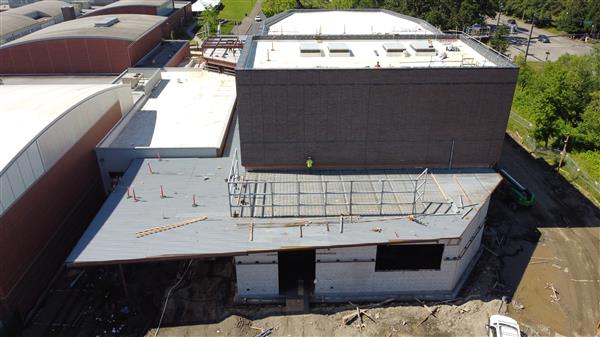

    Recent Activities:

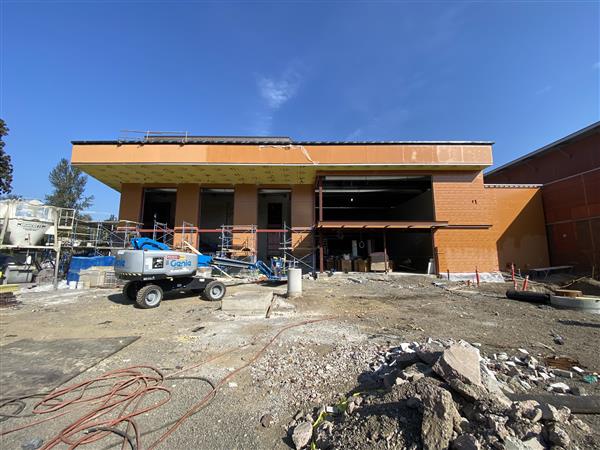

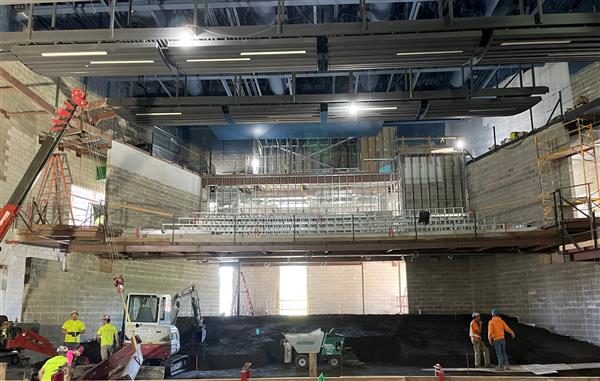

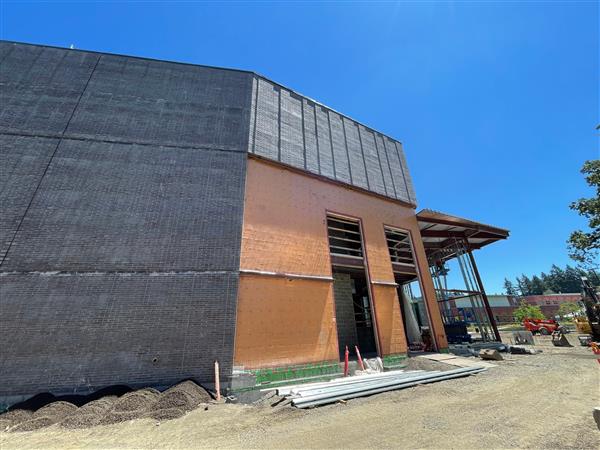

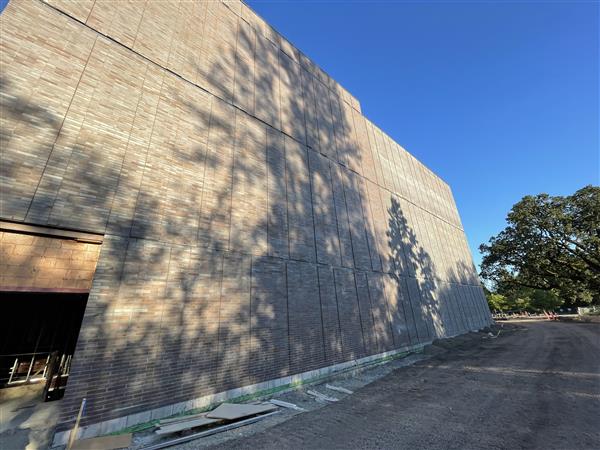

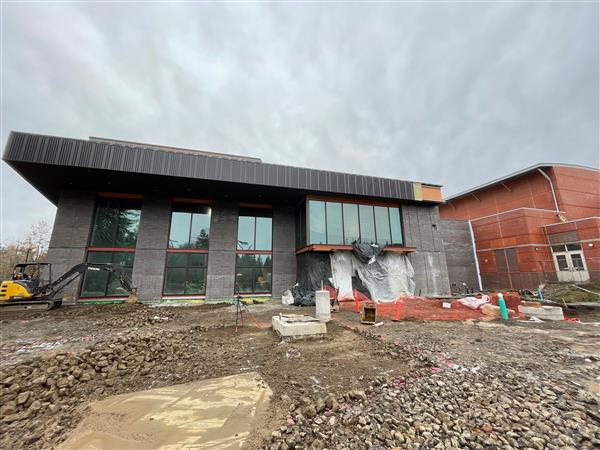

    ■ Exterior brick is over 75% installed
    ■ Mechanical, Electrical and Plumbing rough-in continues throughout. Inter building connections have begun

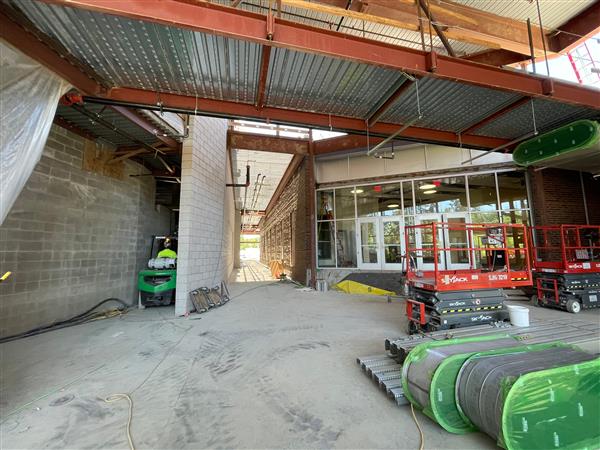

    ■ Framing for the South lobby exterior wall has begun
    ■ New sewer main relocated and installed
    ■ Concessions stand re-roof is nearing completion
    ■ Excavation for the artificial turf softball field has begun
    ■ Musco light poles and light heads have been installed

    Upcoming Activities:
    ■ Internal stairwell steel
    ■ Framing of the North lobby
    ■ Completion of the concrete slabs
    ■ Site access entry rework at school main entry
    ■ North parking lot work to begin
    ■ Security upgrades in existing building to start

    Comments (-1)
  • Bond Construction Update: Wilsonville High School Auditorium

    Posted by West Linn - Wilsonville School District on 7/19/2022

    Have you noticed all the construction going on at Wilsonville High School? Check out the latest project update on the new auditorium being built at Wilsonville High School. Work on the project is being designed not only for the school, but also to be used by the entire Wilsonville community.

    Comments (-1)

  • 2022 Q1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/28/2022

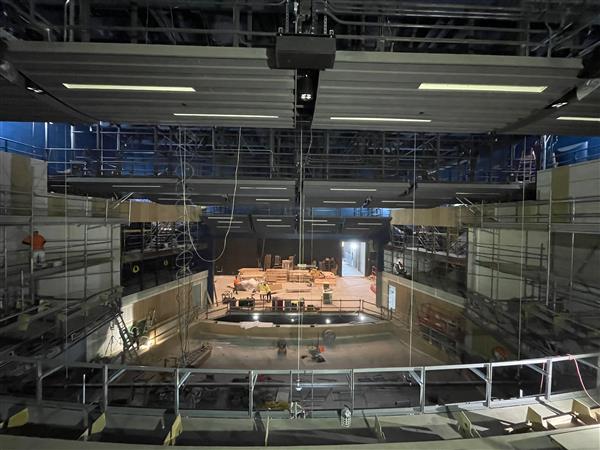

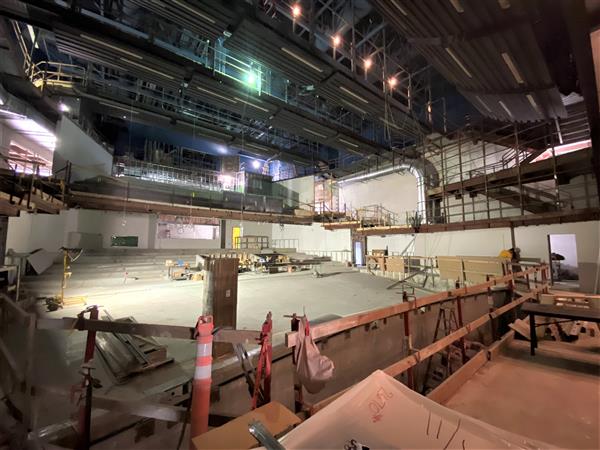

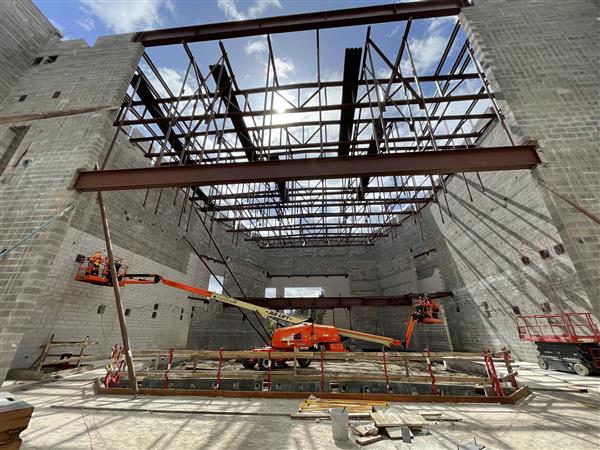

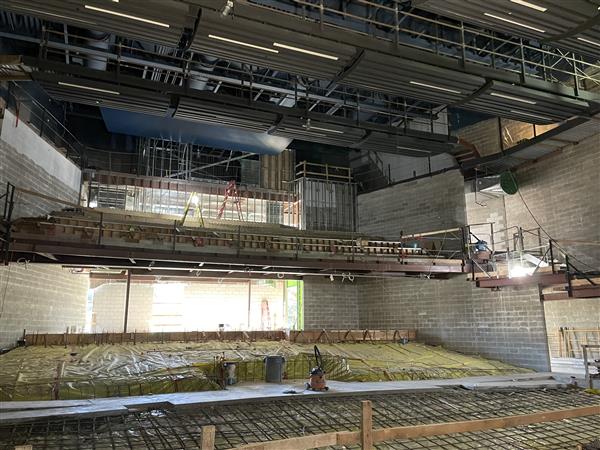

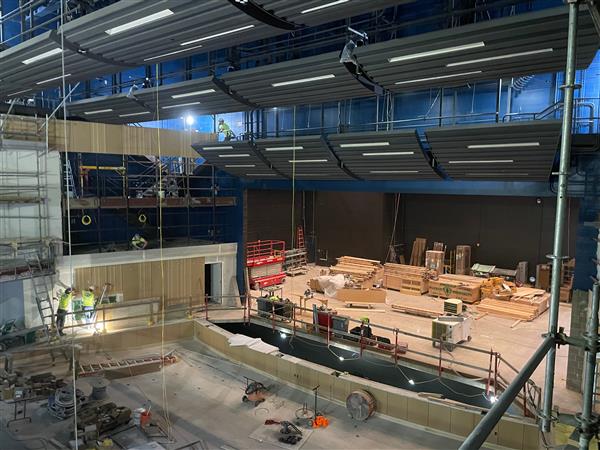

    View from auditorium stage

    Recent Activities:

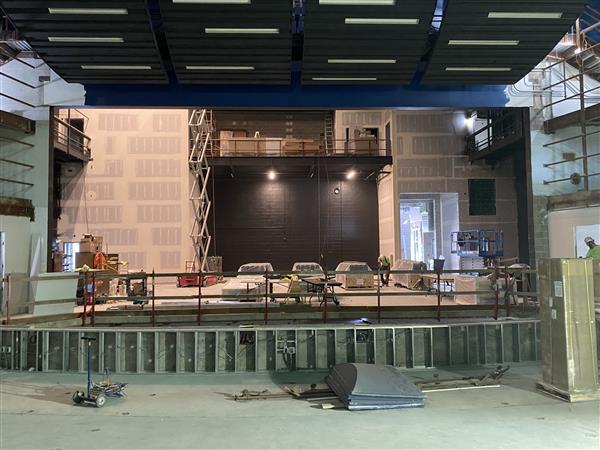

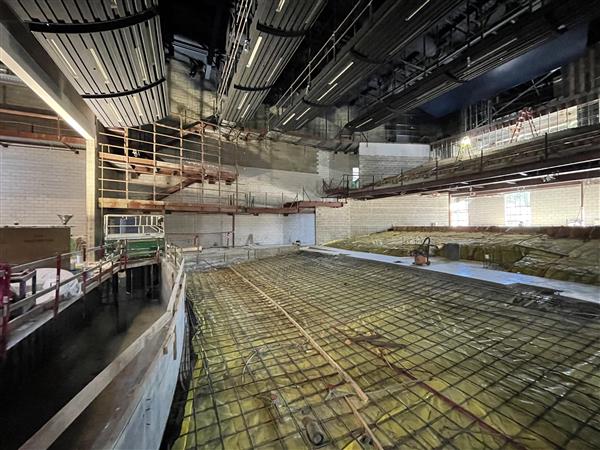

    ■ Main auditorium roof trusses are in place
    ■ Catwalks are being installed
    ■ Balcony steel is going in place
    ■ Weather proofing is being applied to exterior face of the building
    ■ Exploratory work for mechanical system connection to the new addition is taking place

    Upcoming Activities:
    ■ Exterior brick to be installed
    ■ Mechanical, electrical and plumbing in the new lobby restrooms
    ■ Footings for both lobbies to be excavated and poured
    ■ Installation of sewer main relocation

    Comments (-1)

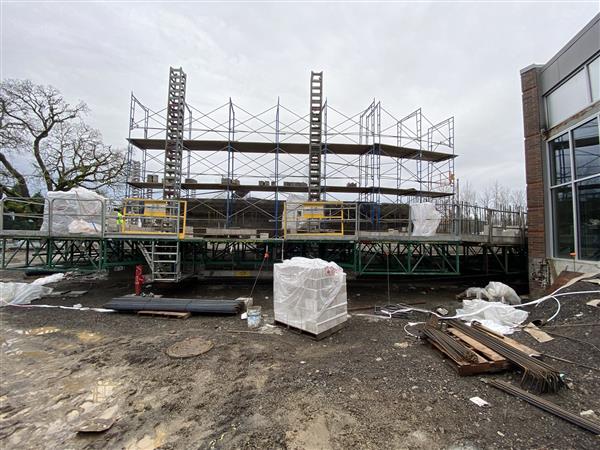

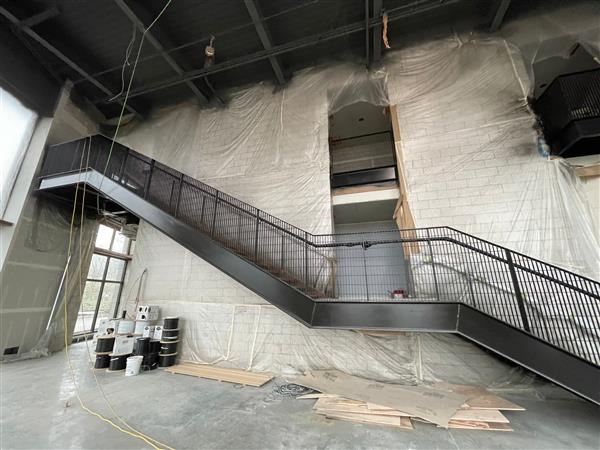

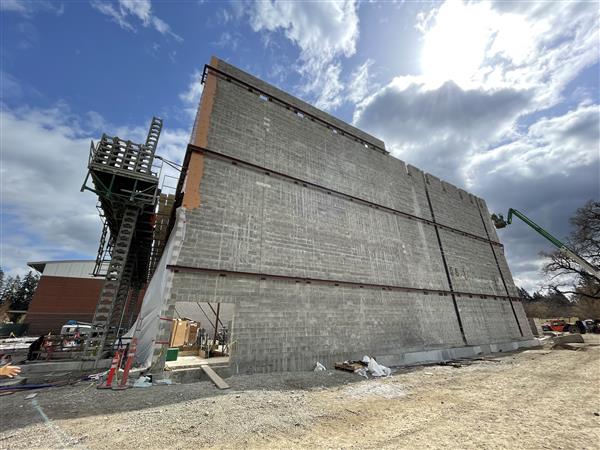

  • 2021 Q4 Project Updates

    Posted by West Linn - Wilsonville School District on 1/21/2022

    Recent Activities:

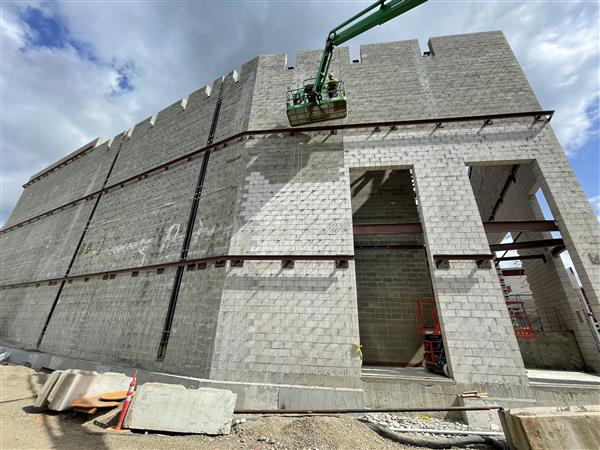

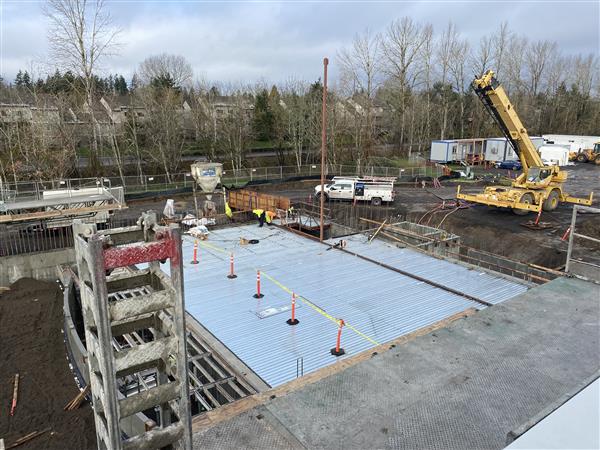

    ■ Sub grade foundations and walls are complete
    ■ Basement slab is complete
    ■ Phased sewer line relocation has begun
    ■ Interior block wall erection has begun
    ■ Single occupant restrooms walls are framed and Mechanical Electrical and Plumbing work is nearing completion
    ■ New drama office framing has begun

    Upcoming Activities:
    ■ Basement back fill starting soon
    ■ Shallow footings for shop and lobby walls
    ■ Central core block walls will continue to rise along with concurrent Mechanical Electrical and Plumbing install
    ■ Elevated stage deck concrete pour
    ■ Auditorium house Mechanical Electrical and Plumbing underground install and slab prep work
    ■ Preparatory work to facilitate upcoming summer building work

    WHS Construction

    Comments (-1)

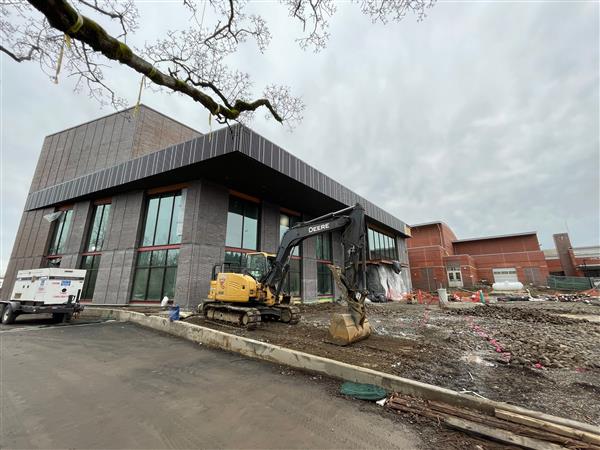

  • WHS Performing Arts Project Update

    Posted by West Linn - Wilsonville School District on 11/15/2021

    WHS Performing Arts Center Project

    The main entrance to Wilsonville High School opened before school started with a rerouted PGE service line, new conduit for the new service to the theater and temporary public circulation routes. Next summer work for the final entrance and courtyard will take place.

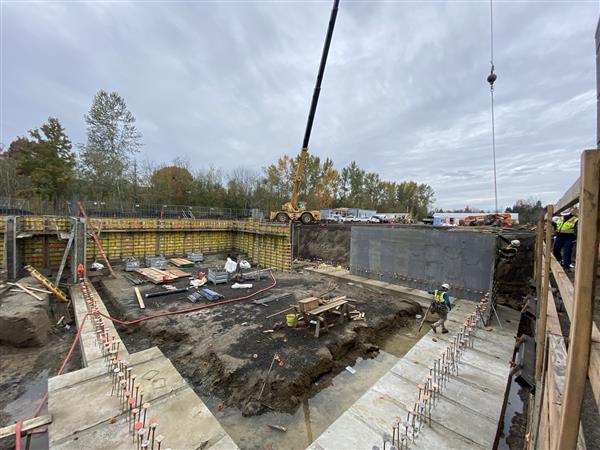

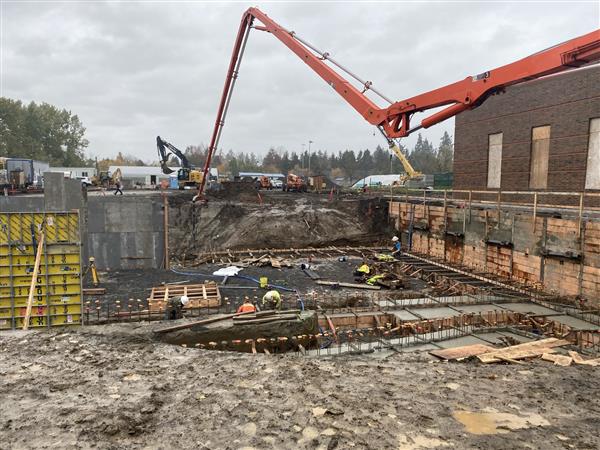

    The contractor continues work laying the foundations for the new theater building.  Mass excavations reach a depth of 15 feet (the deepest section under the stage). Footings for the internal core of the structure are complete and below grade walls are currently being formed and poured. Soon the structure will rise above existing grade.

    Demolition work started at the end of the existing band hallway in support of connecting the new theater building to the existing school.  Over Thanksgiving break, the general contractor will be expanding their work in the existing building in support of the new mechanical, plumbing and electrical work required in this interface zone between the new and existing buildings. This work is occurring while continuing to maintain separation between construction and school functions.The new theater addition is still expected to be complete in late 2022.

    Site construction

    Comments (-1)

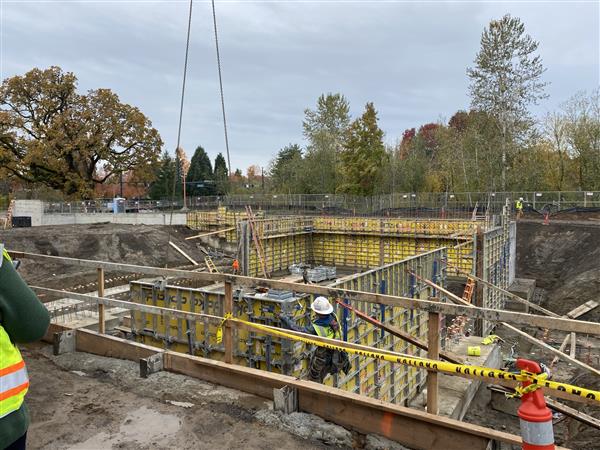

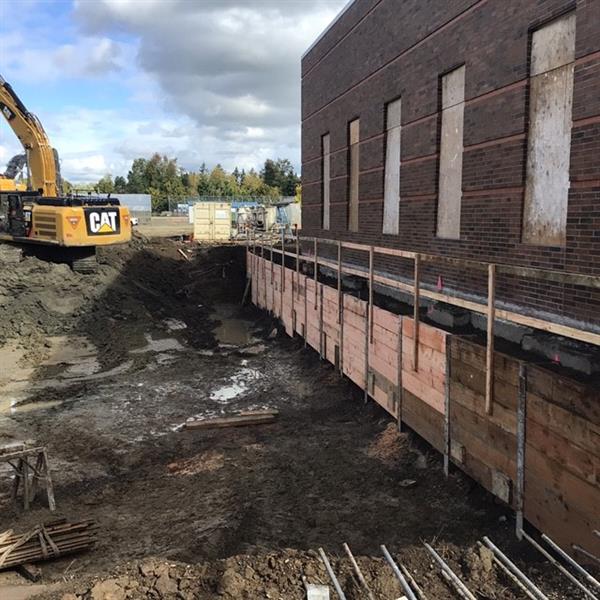

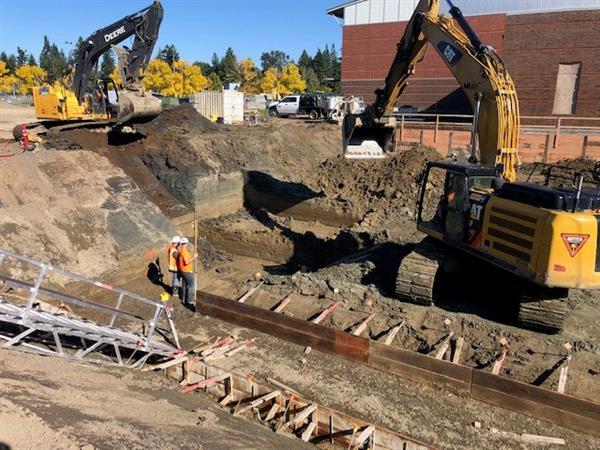

  • 2021 Q3 Project Updates

    Posted by West Linn - Wilsonville School District on 10/21/2021

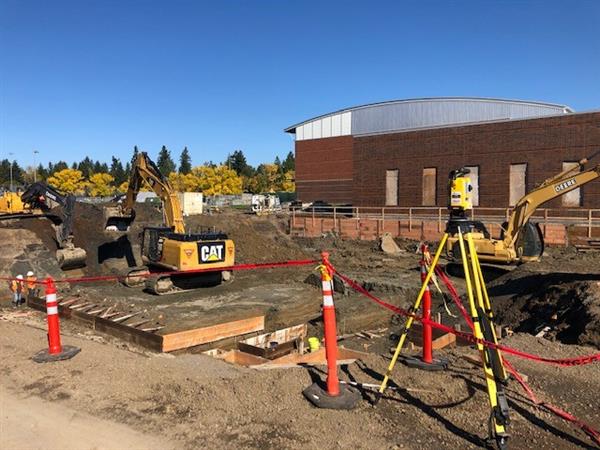

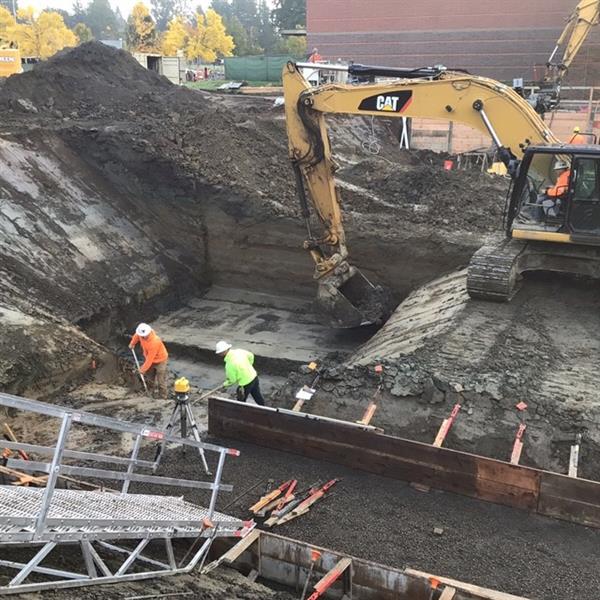

    Construction work

    Recent Activities:
    ■ Contractor has mobilized and cleared the site
    ■ Band room shoring has been completed
    ■ 130 yards of concrete has been poured as the contractor begins the footings for the new construction
    ■ Value engineering continuing on the project

    Upcoming Activities:
    ■ Construction of new footings
    ■ Demo work at the interface between new and existing building
    ■ Procurement of construction material and major systems of the building

    Comments (-1)
  • 2021 Q2 Project Updates

    Posted by West Linn - Wilsonville School District on 8/4/2021

    Recent Activities:
    ■ Bids were received end of June
    ■ Board approval to execute contract with low bidder, Todd Construction
    ■ Construction contract value is $27,834,000.00
    ■ Value engineering continuing on the project
    ■ First City of Wilsonville building permit review

    Upcoming Activities:
    ■ Contractor mobilization to start early July
    ■ Site work anticipated once permitting is done, end of July
    ■ Front entry access expected to be restored prior to start of school

    Comments (-1)
  • 2021 Quarter 1 Project Updates

    Posted by West Linn - Wilsonville School District on 4/22/2021

    Recent Activities:
    ■ Construction Documents are approximately 65% complete and are currently under district review
    ■ Continuation of focus groups to discuss design details, including staff, students and community partners
    ■ Submitted for completeness review of Land Use Documentation
    ■ Pre-Qualification bidding strategy findings presented to the School Board and approved

    Upcoming Activities:
    ■ General Contractor pre-qualification expected to launch in April
    ■ Finalize logistics package for construction
    ■ Final estimates expected in April
    ■ General contractor bids expected in June with construction anticipated to start in August

    Comments (-1)
  • Quarter 4 Project Updates

    Posted by West Linn - Wilsonville School District on 2/2/2021

    Recent Activities:
    ■ Project design moved into Construction Document phase
    ■ Continuation of focus groups to discuss design details, including staff, students and community partners
    ■ Submitting for completeness review of Land Use Documentation

    Upcoming Activities:
    ■ General Contractor pre-qualification solicitation
    ■ Virtual Community Meeting scheduled for February 2021
    ■ Development of Construction Phasing and Logistics Plan

    Auditorium Rendering

    Driveway rendering

    North View Rendering of Auditorium

    Comments (-1)
  • WHS Community Engagement Meeting Feb 3rd

    Posted by Amy Berger on 1/22/2021

    West Linn-Wilsonville Community Members, The West Linn-Wilsonville School District will host a Community Engagement Meeting for the New Auditorium at Wilsonville High School Bond Project on Wednesday, February 3rd, beginning at 6 p.m. This meeting will be virtual through Zoom.

    The West Linn-Wilsonville Bond Team and project architects representatives will provide an overview of the projects design progress including current design and the construction schedule.

    The Zoom information to join the public meeting will be posted to the Bond Website and provided through the WLWV-Bond-WHS-Performing-Arts-Center ListServ on Tuesday, February 2nd. To view recent updates regarding the project, to sign up for ListServ communications, or for more information, please visit the WHS Performing Arts Center Bond Website

    Comments (-1)
